Construction

Project Name Platel Amata Factory
2021/12/06 (After begin construction 50 weeks)

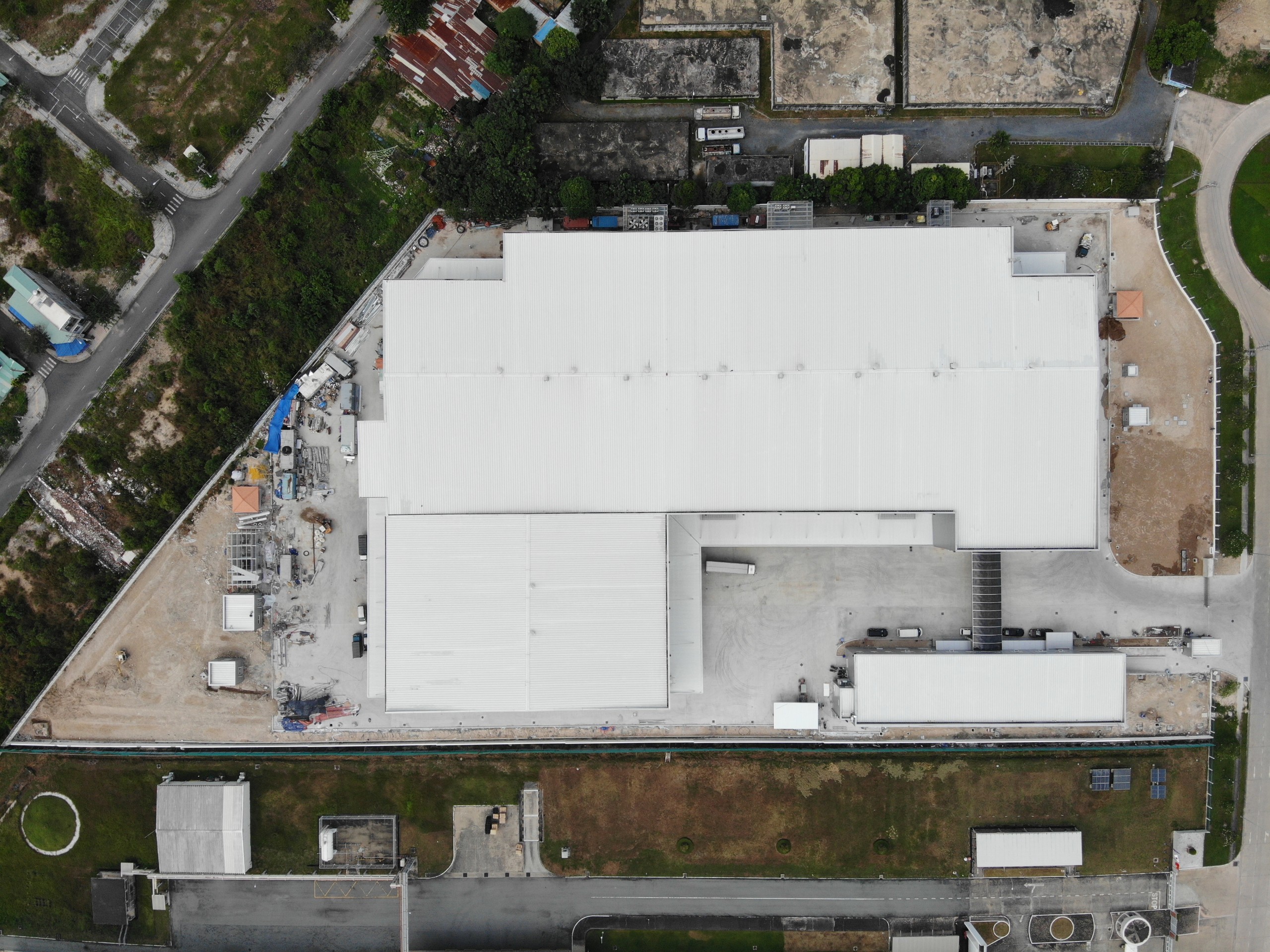

2021/11/13 (After begin construction 49 weeks)

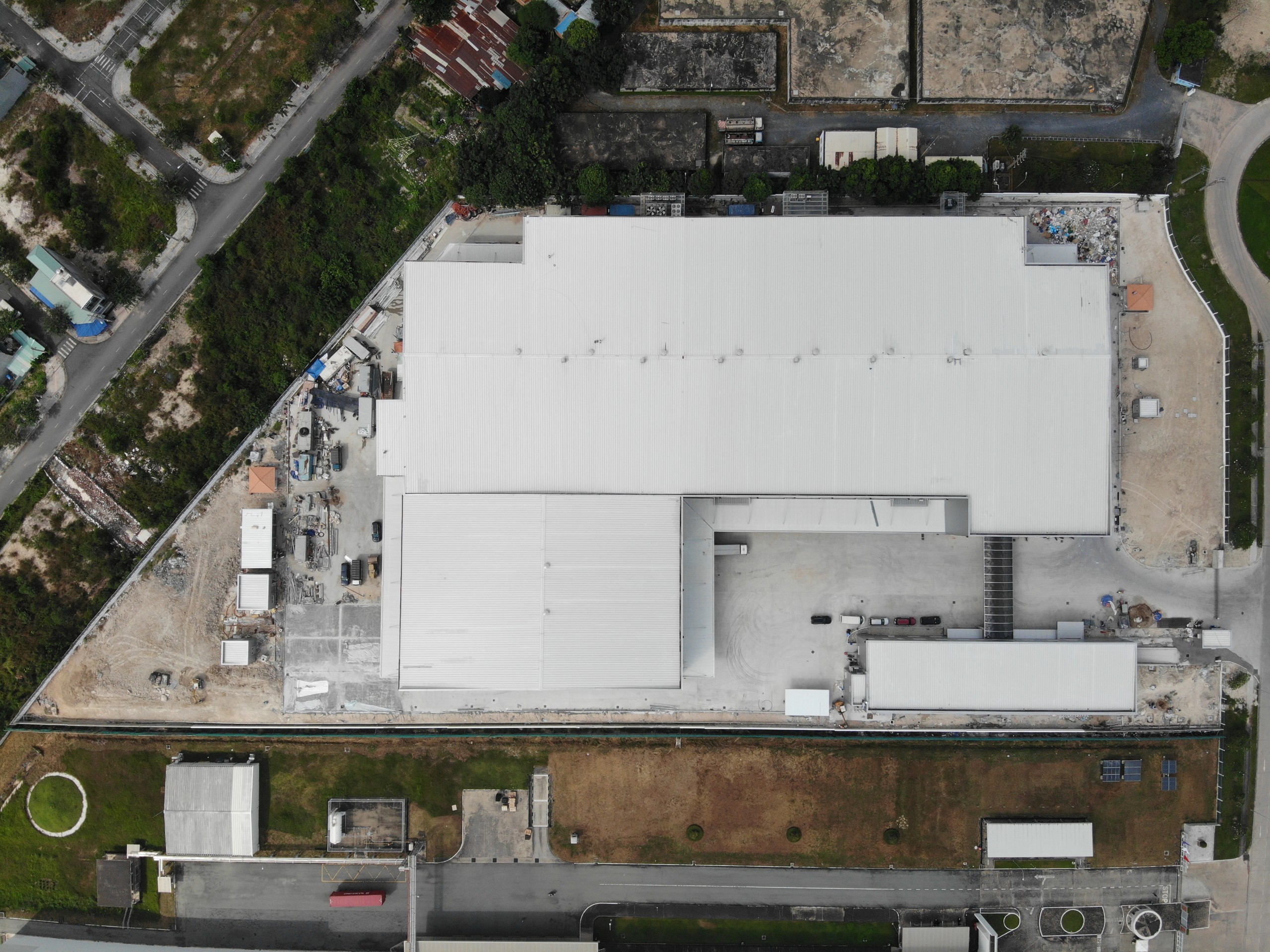

2021/11/05 (After begin construction 48 weeks)

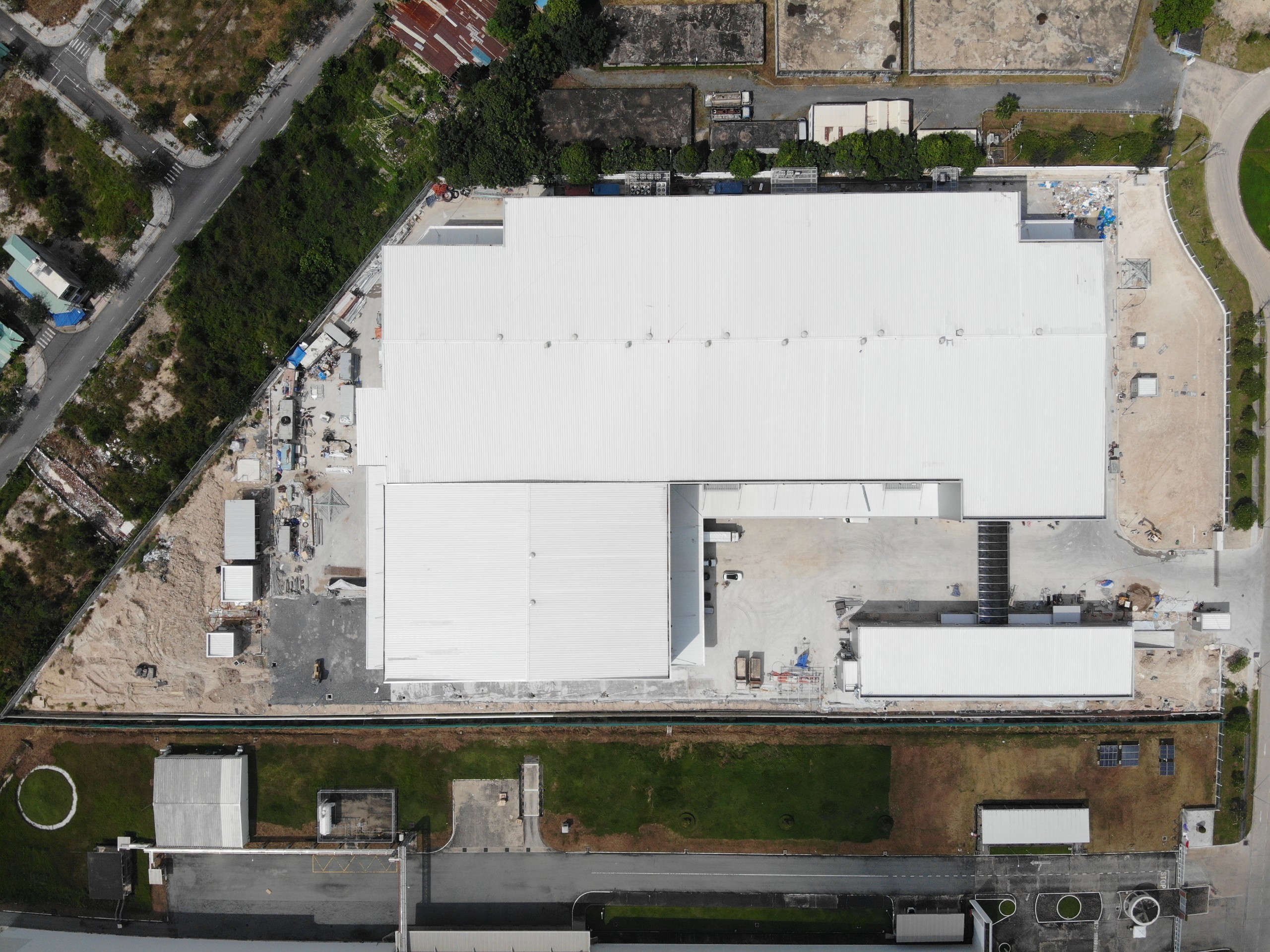

2021/10/31 (After begin construction 47 weeks)

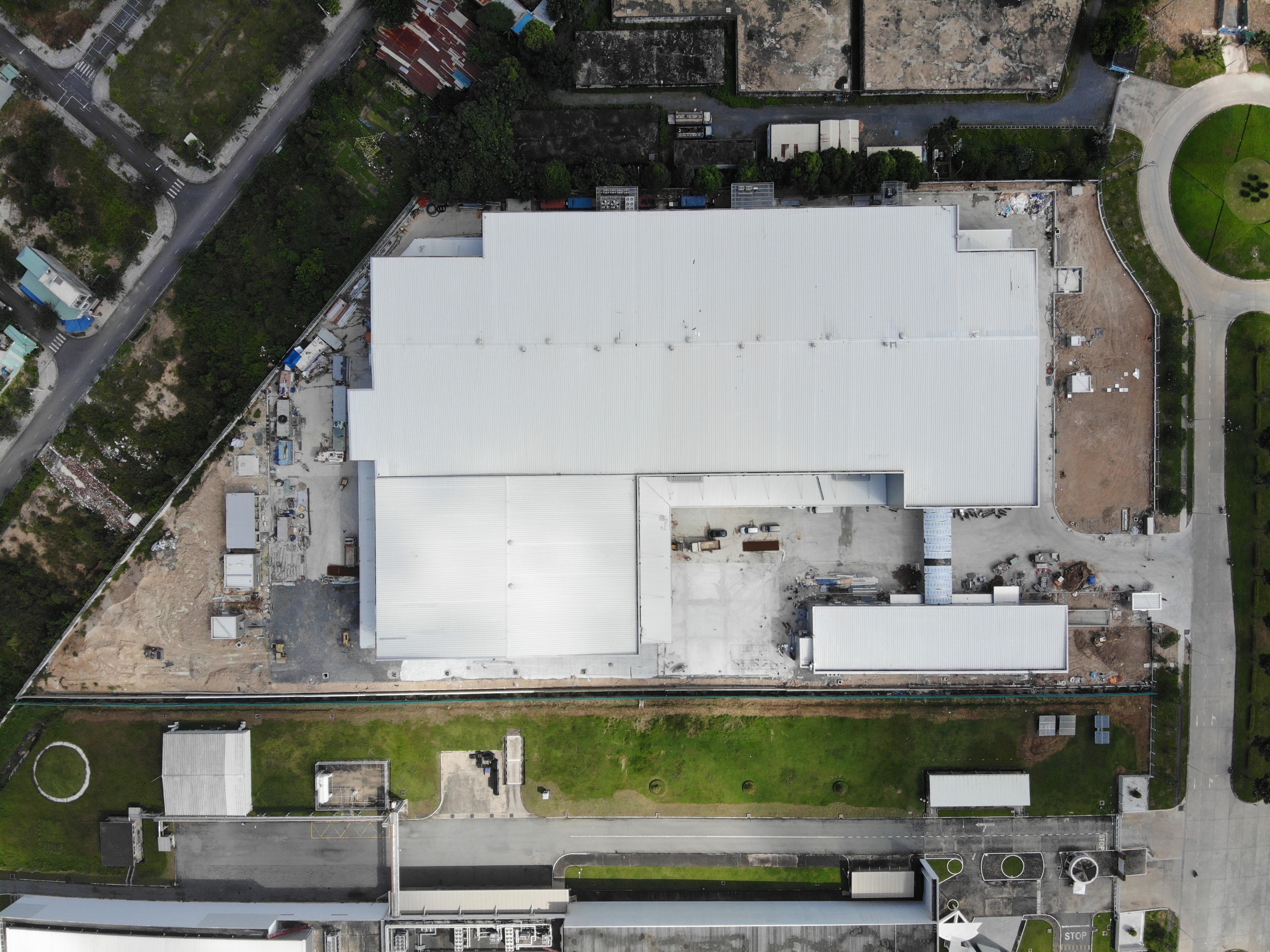

2021/10/23 (After begin construction 46 weeks)

2021/09/14 (After begin construction 40 weeks)

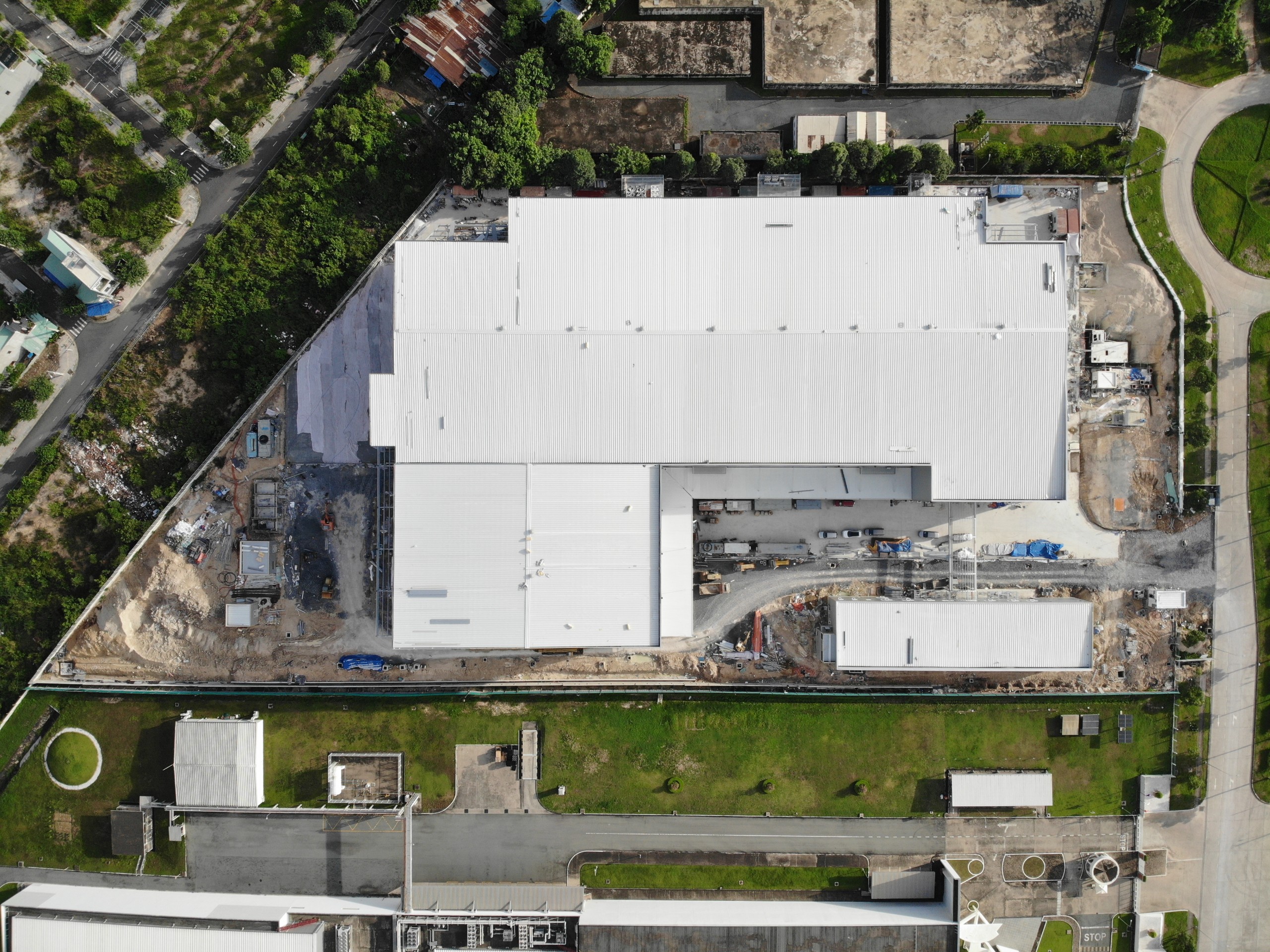

2021/07/27 (After begin construction 33 weeks)

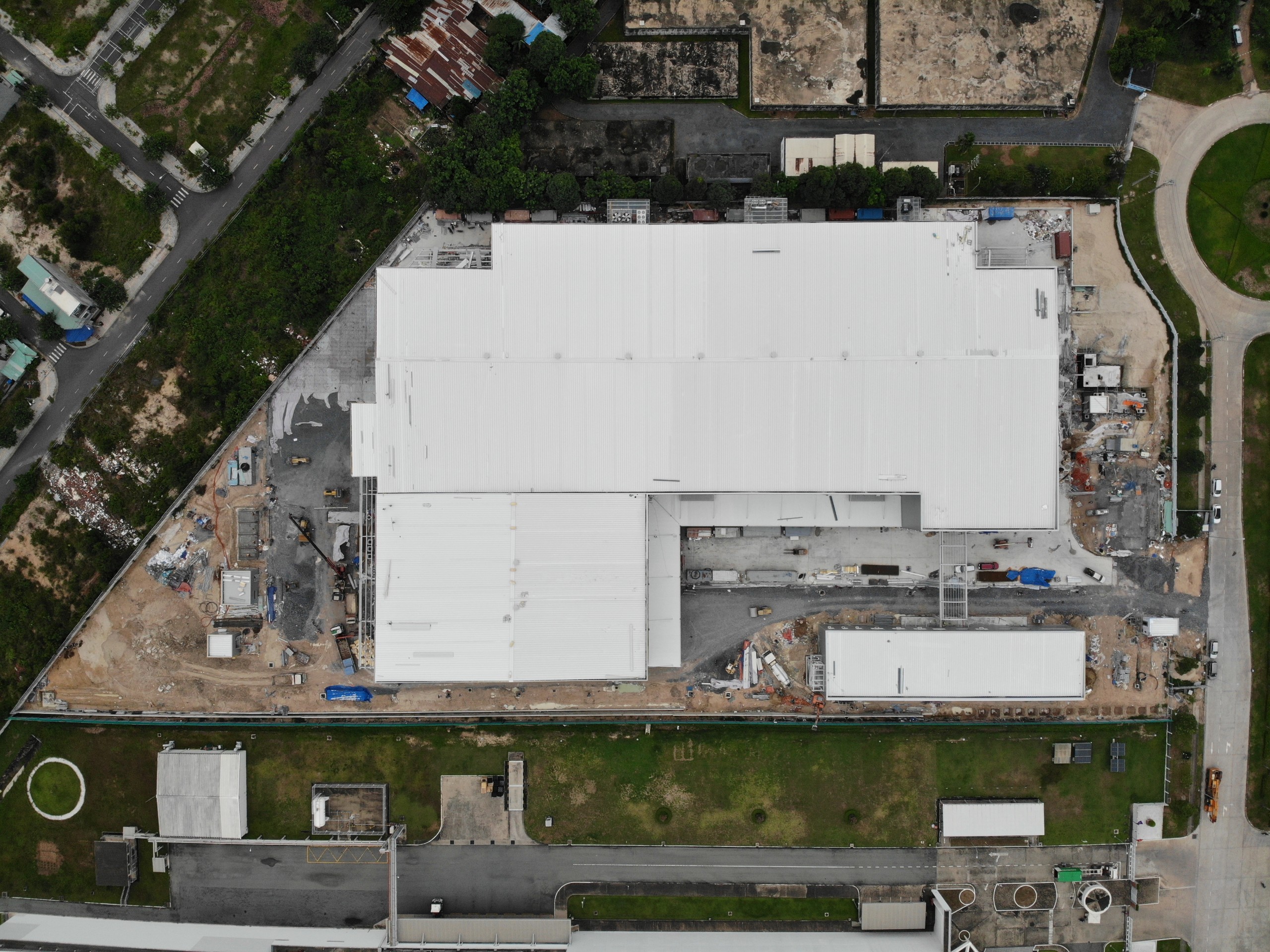

2021/07/21 (After begin construction 32 weeks)

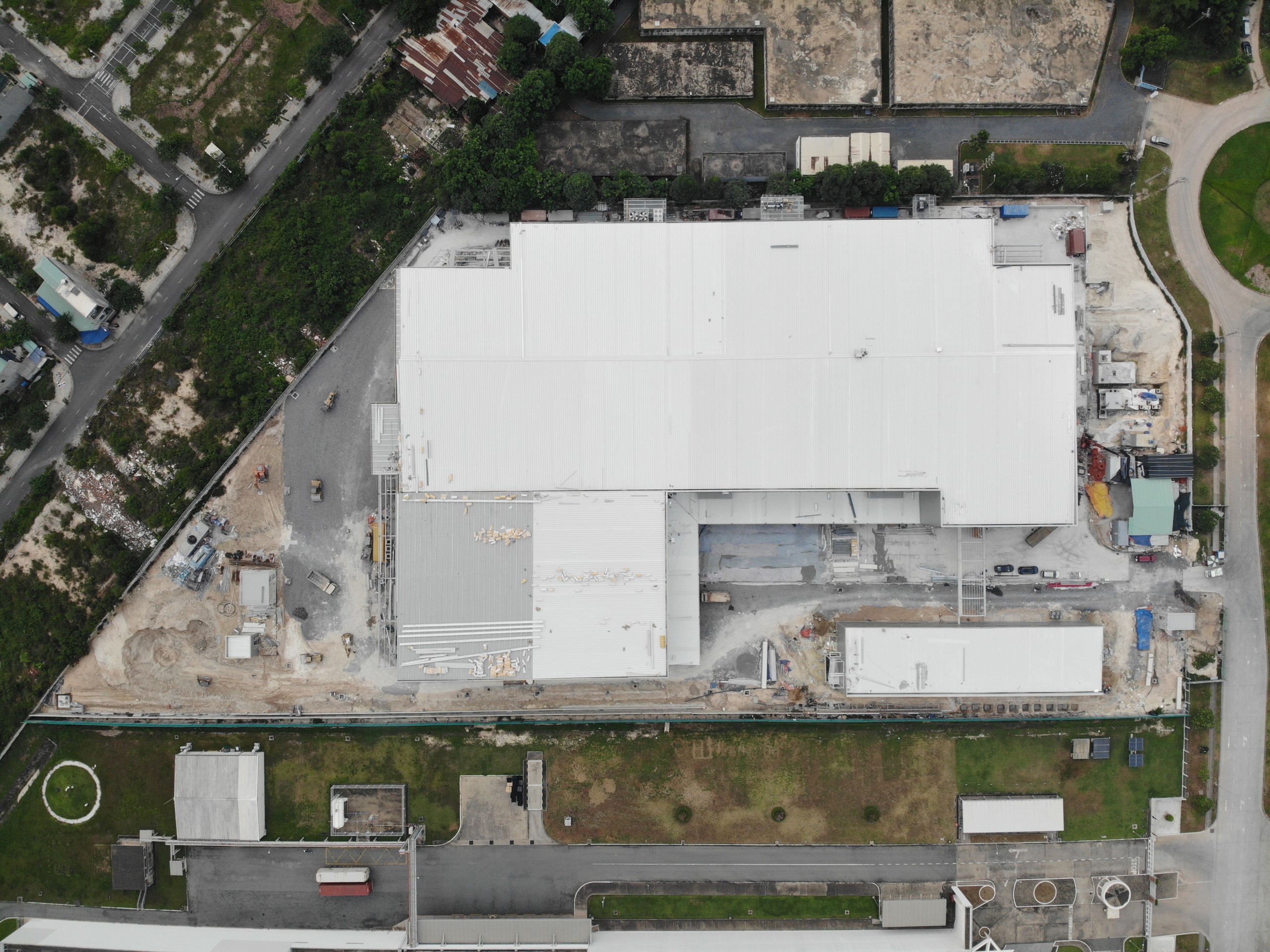

2021/07/13 (After begin construction 31 weeks)

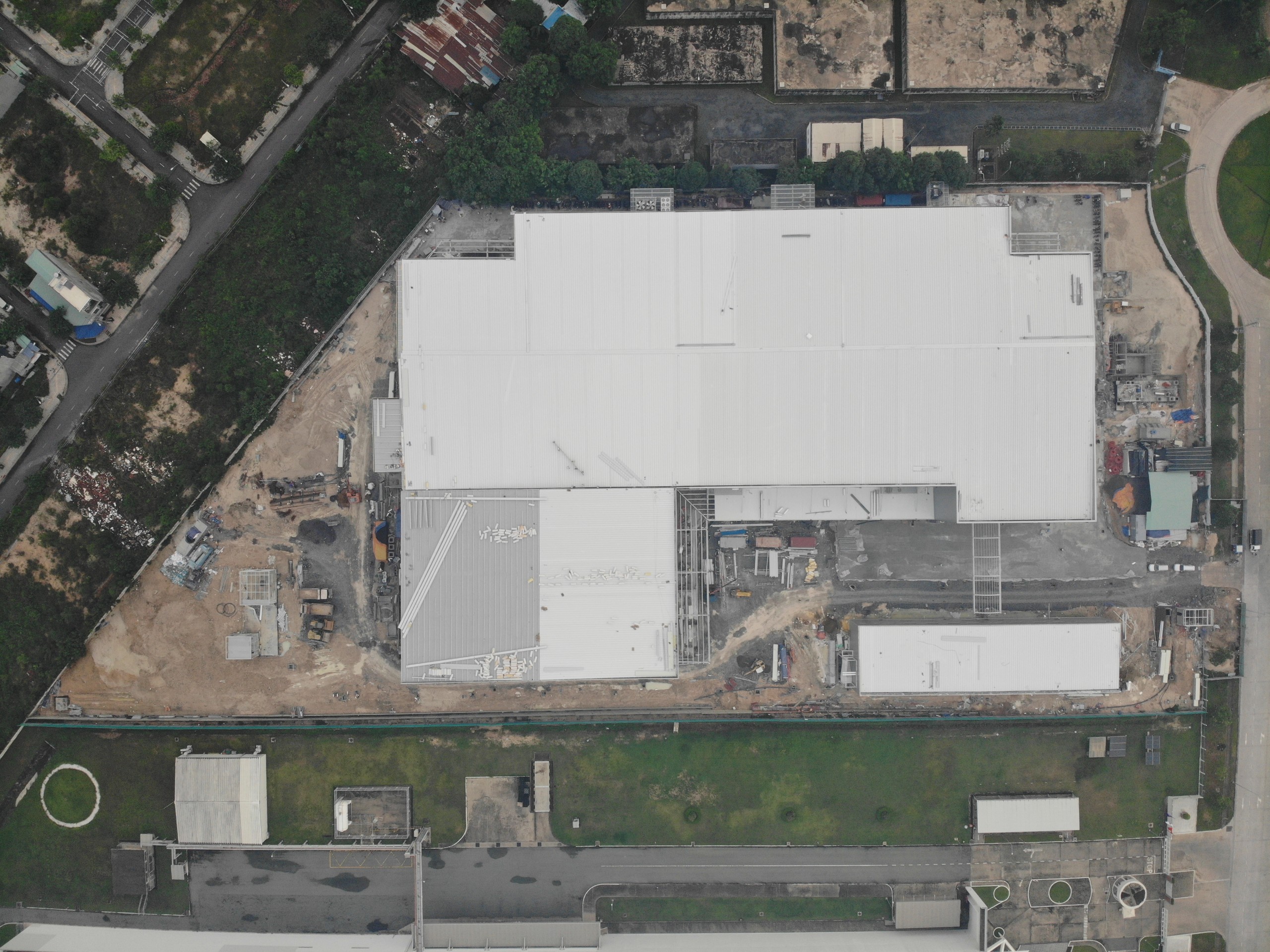

2021/07/06 (After begin construction 30 weeks)

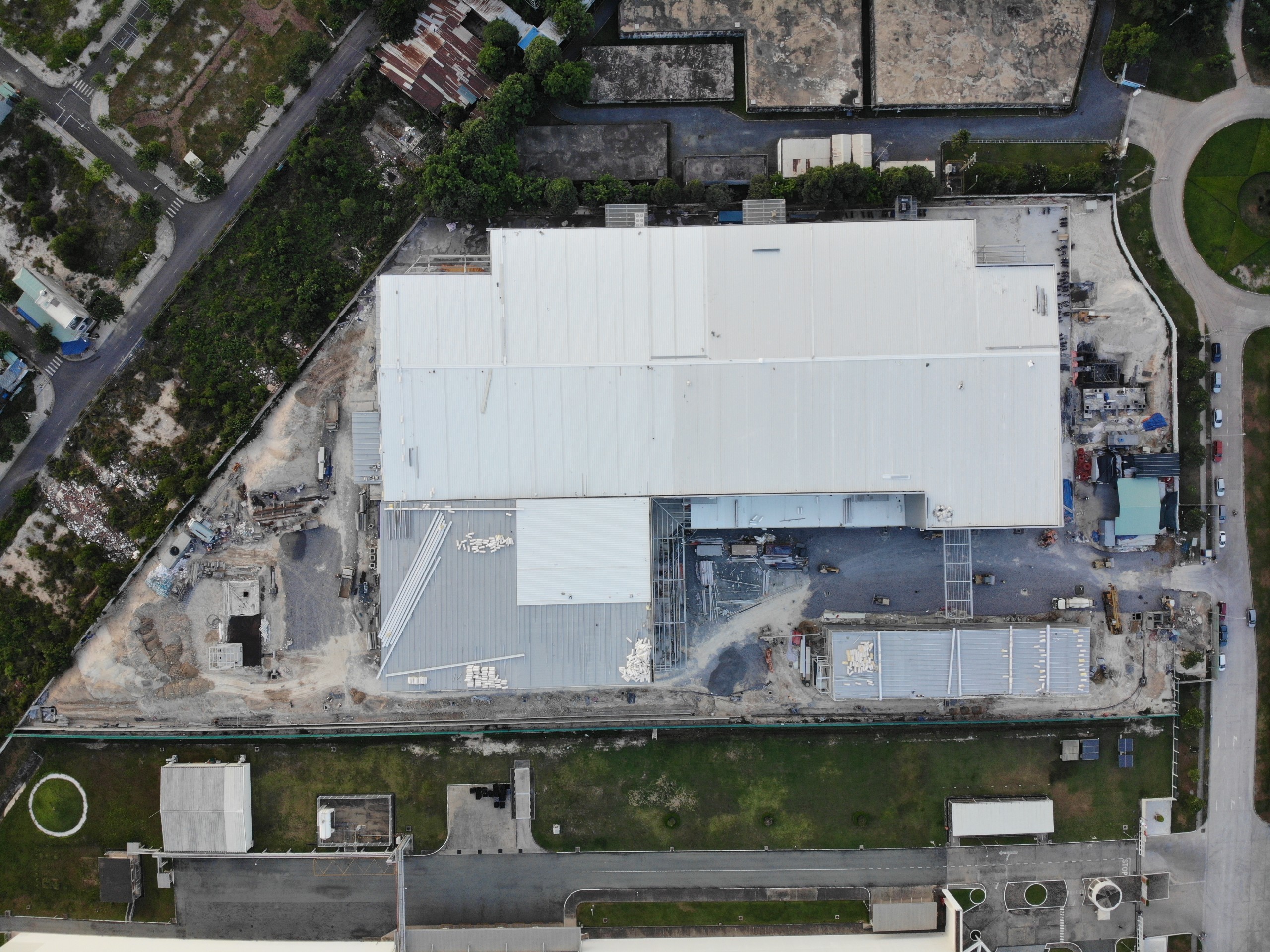

2021/06/30 (After begin construction 29 weeks)

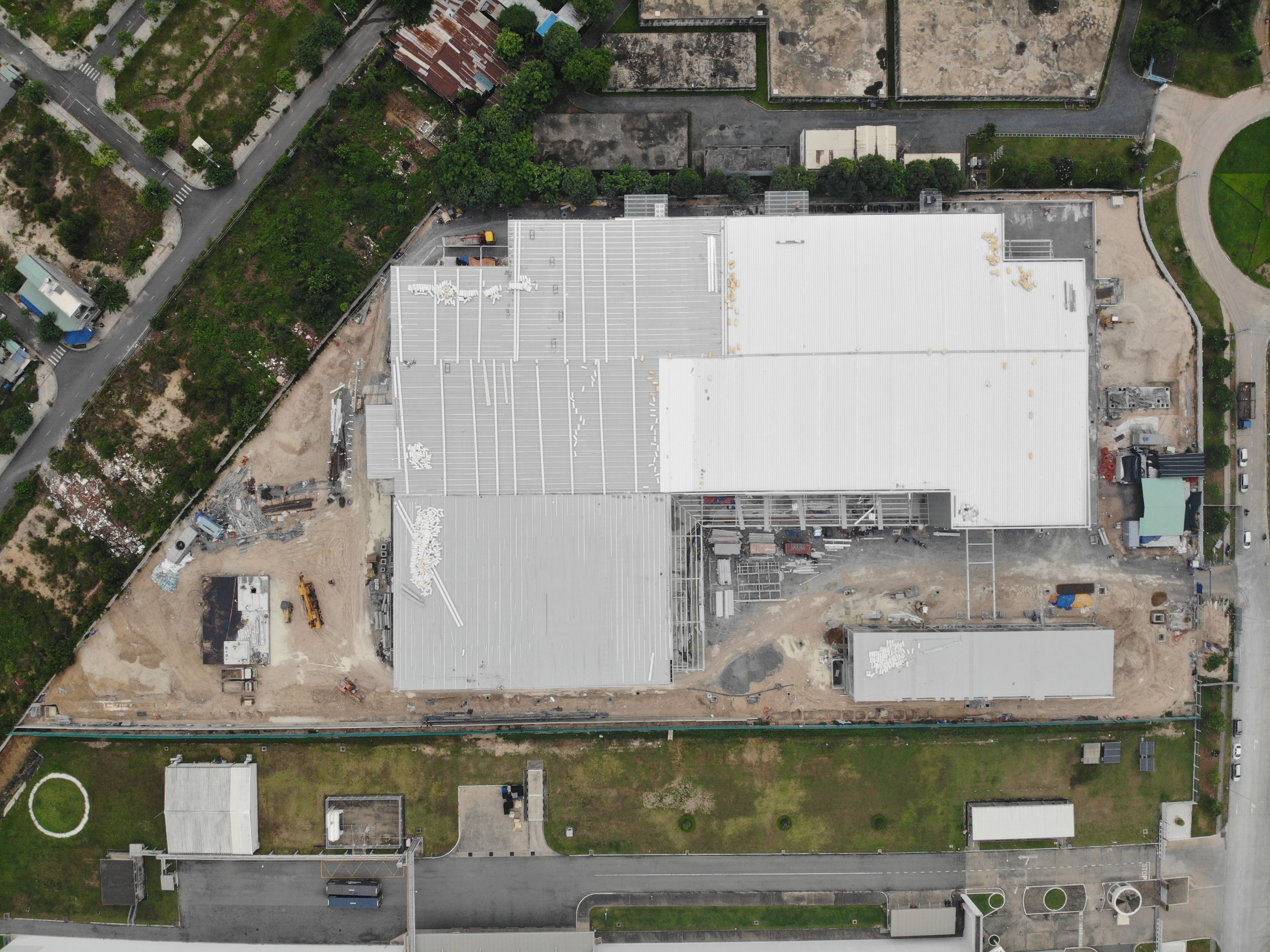

2021/06/22 (After begin construction 28 weeks)

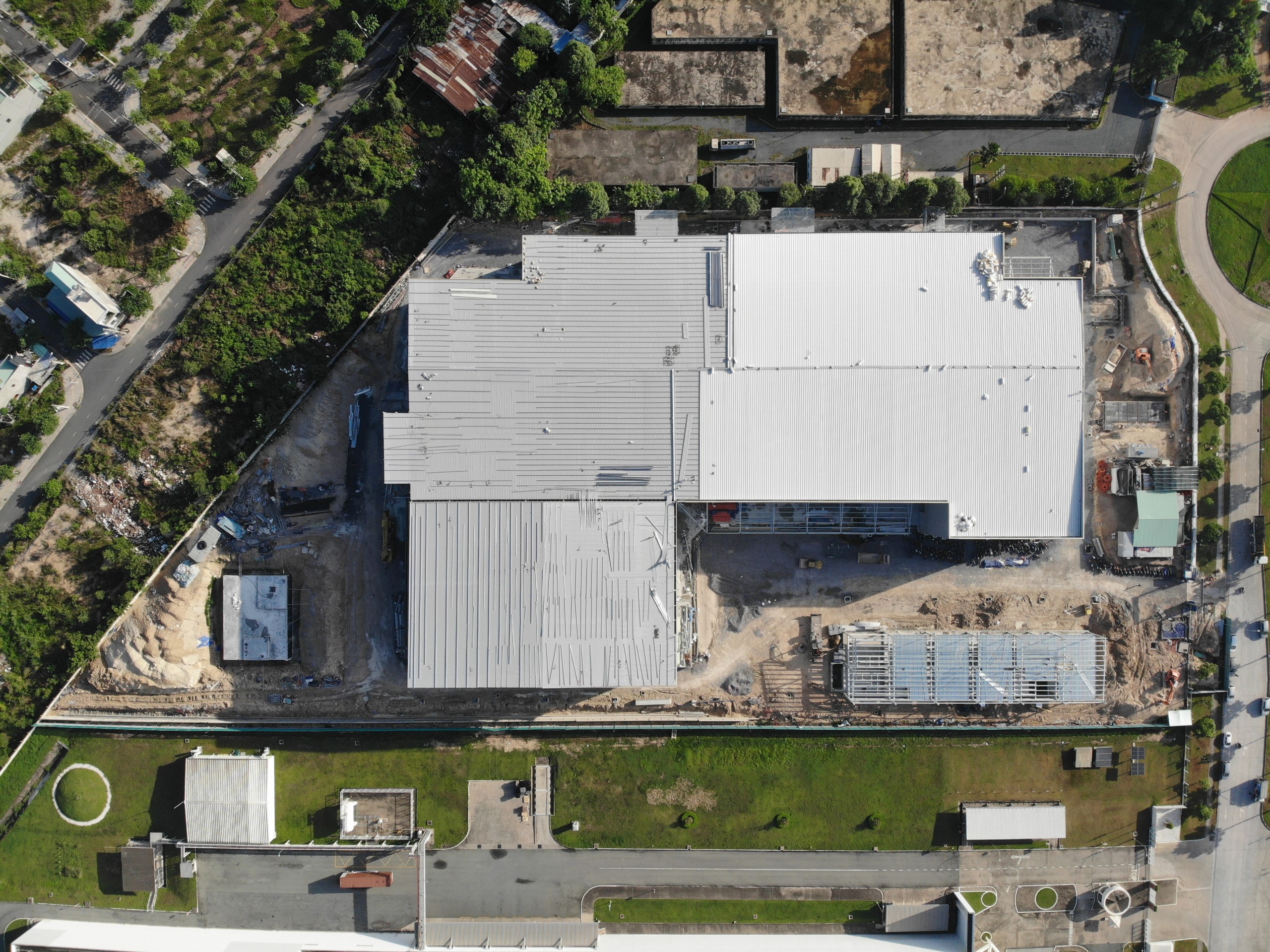

2021/06/17 (After begin construction 27 weeks)

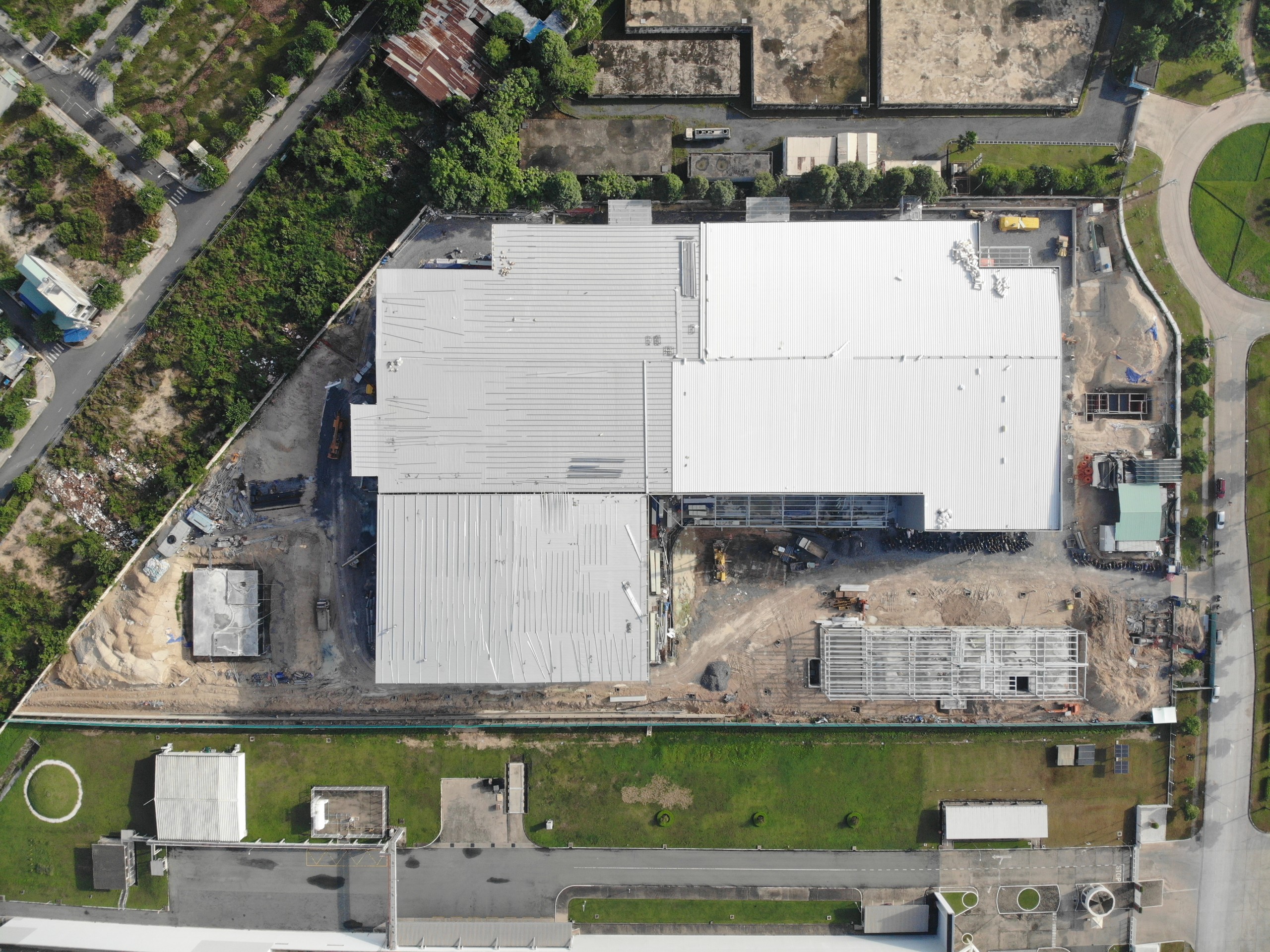

2021/06/10 (After begin construction 26 weeks)

2021/06/03 (After begin construction 25 weeks)

2021/05/27 (After begin construction 24 weeks)

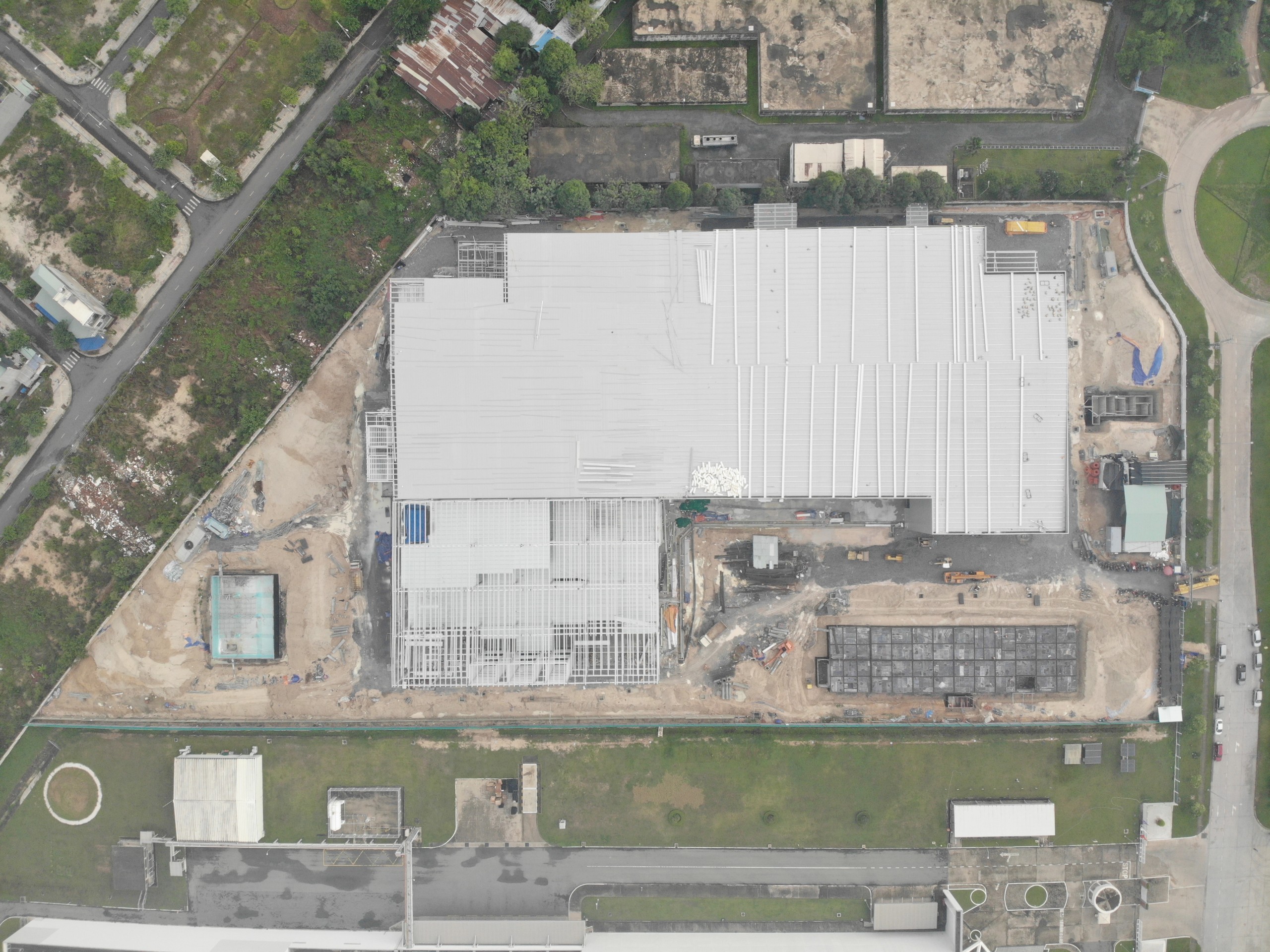

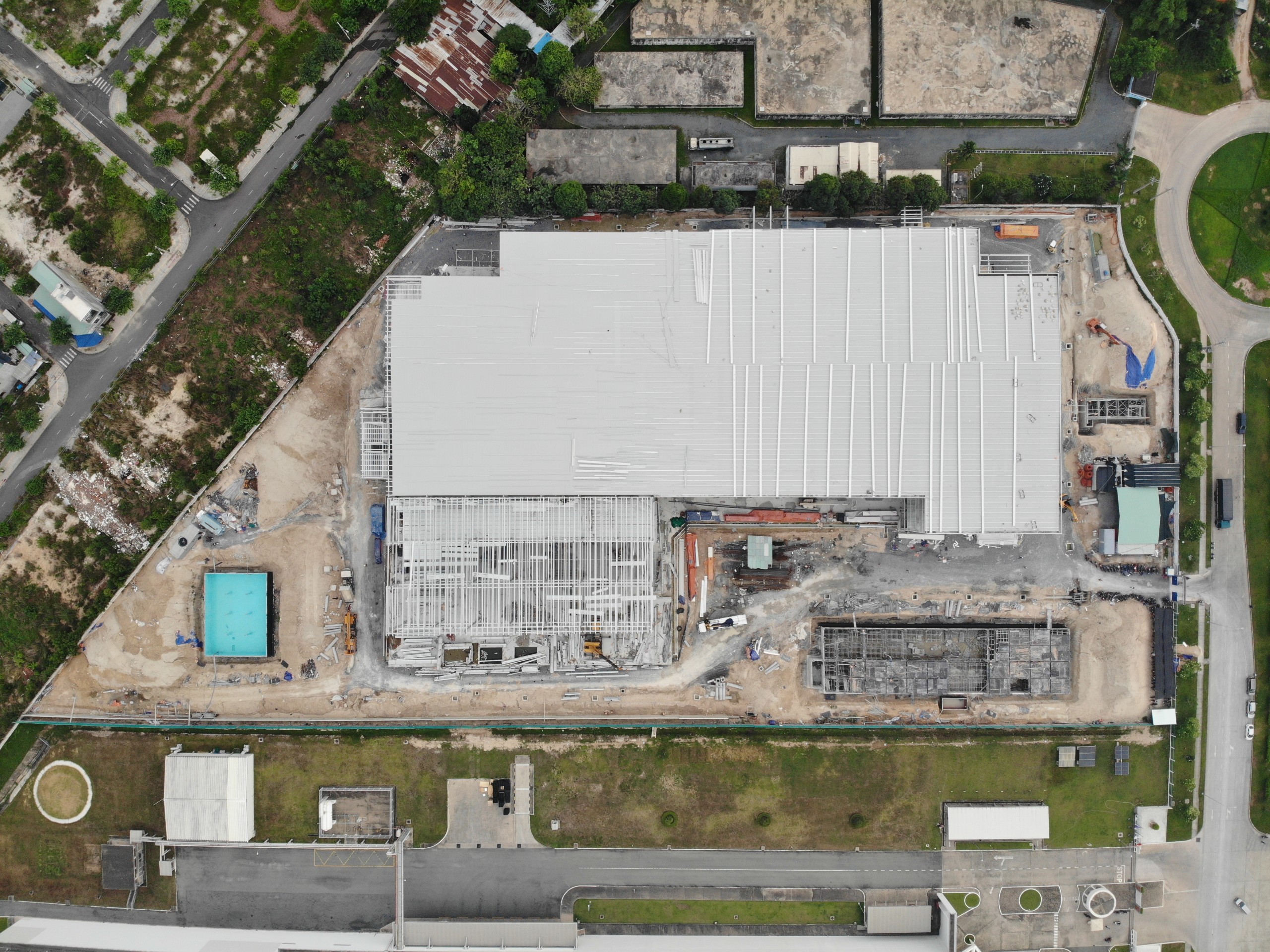

2021/05/21 (After begin construction 23 weeks)

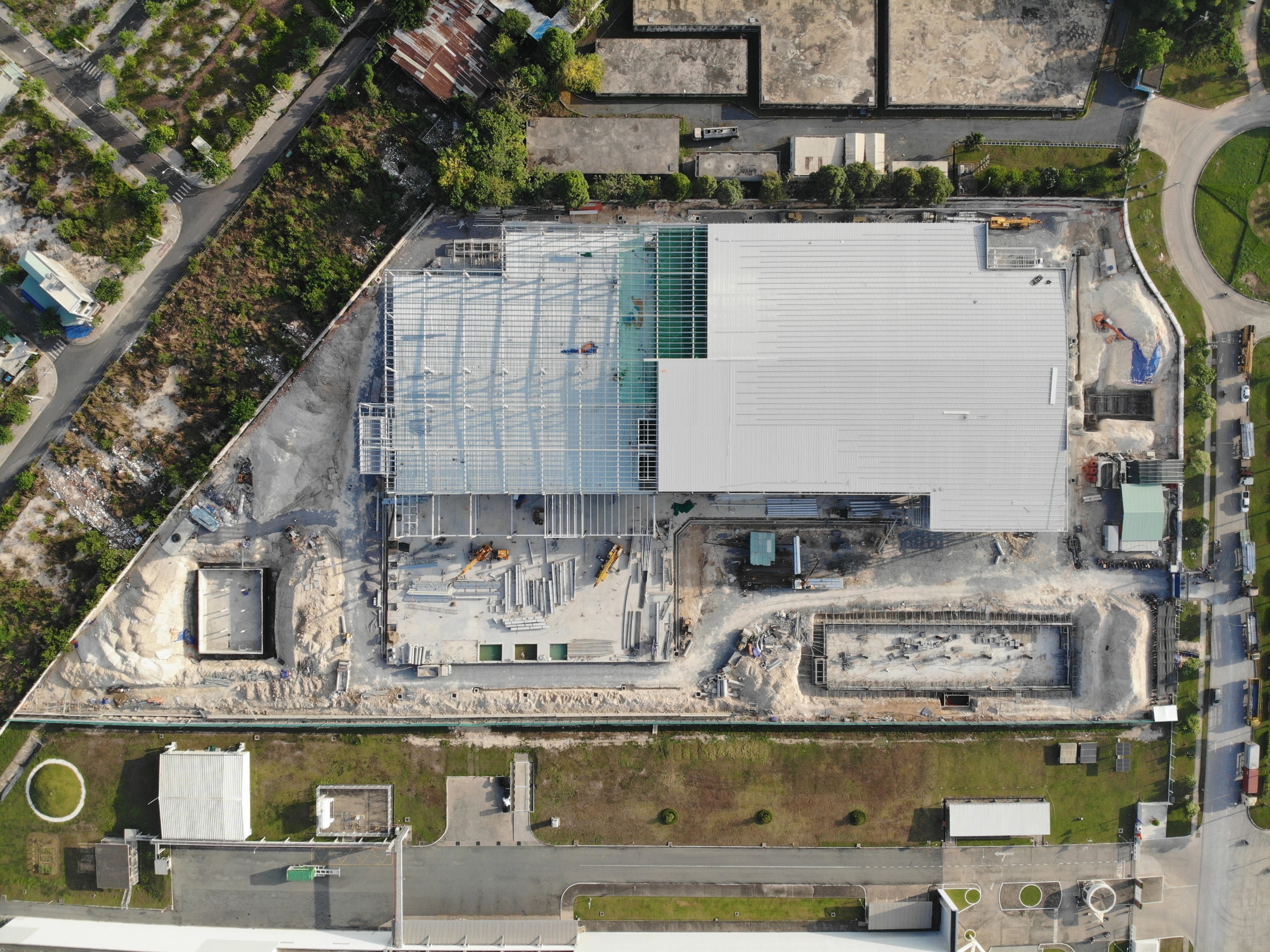

2021/05/13 (After begin construction 22 weeks)

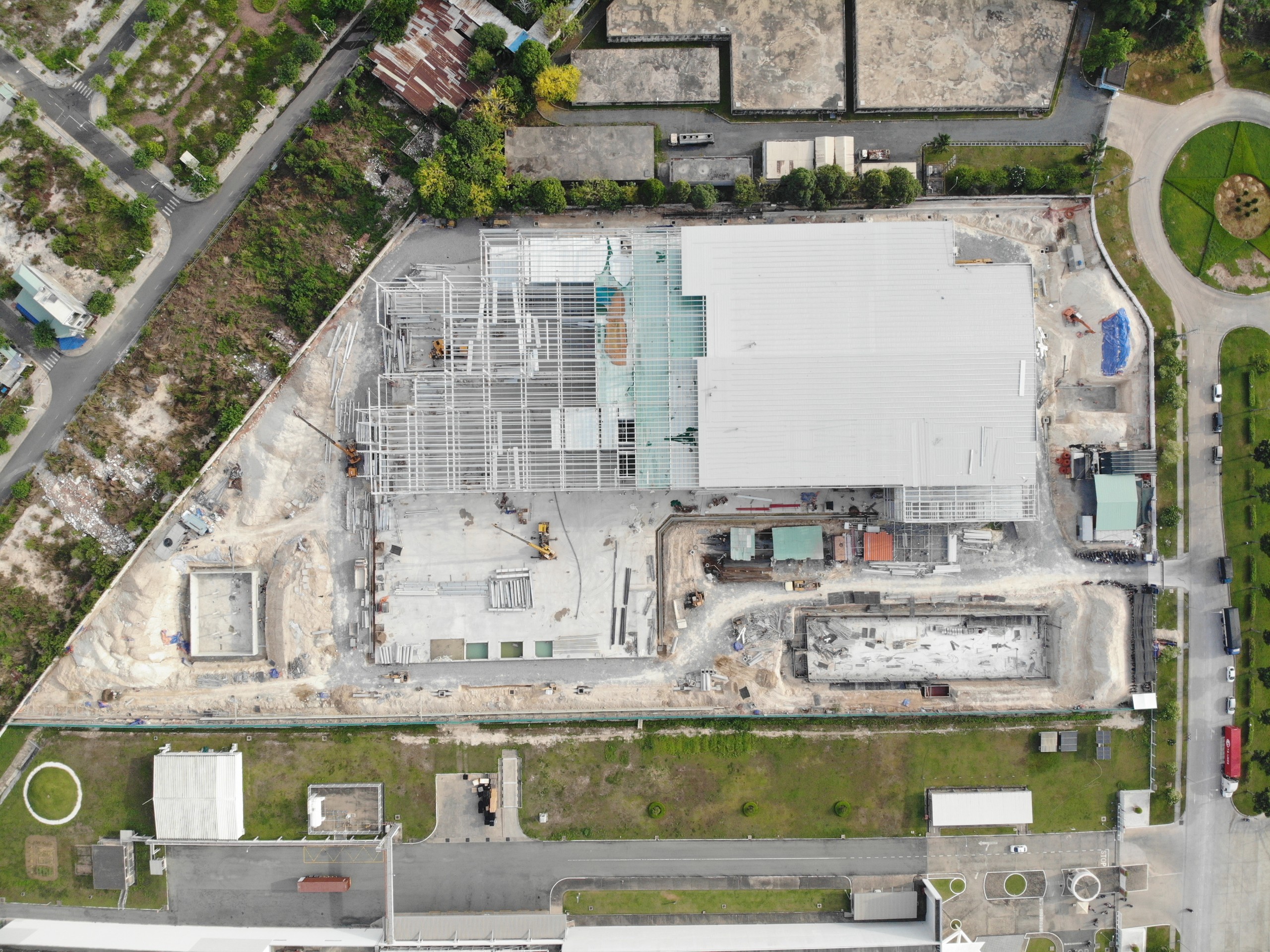

2021/05/07 (After begin construction 21 weeks)

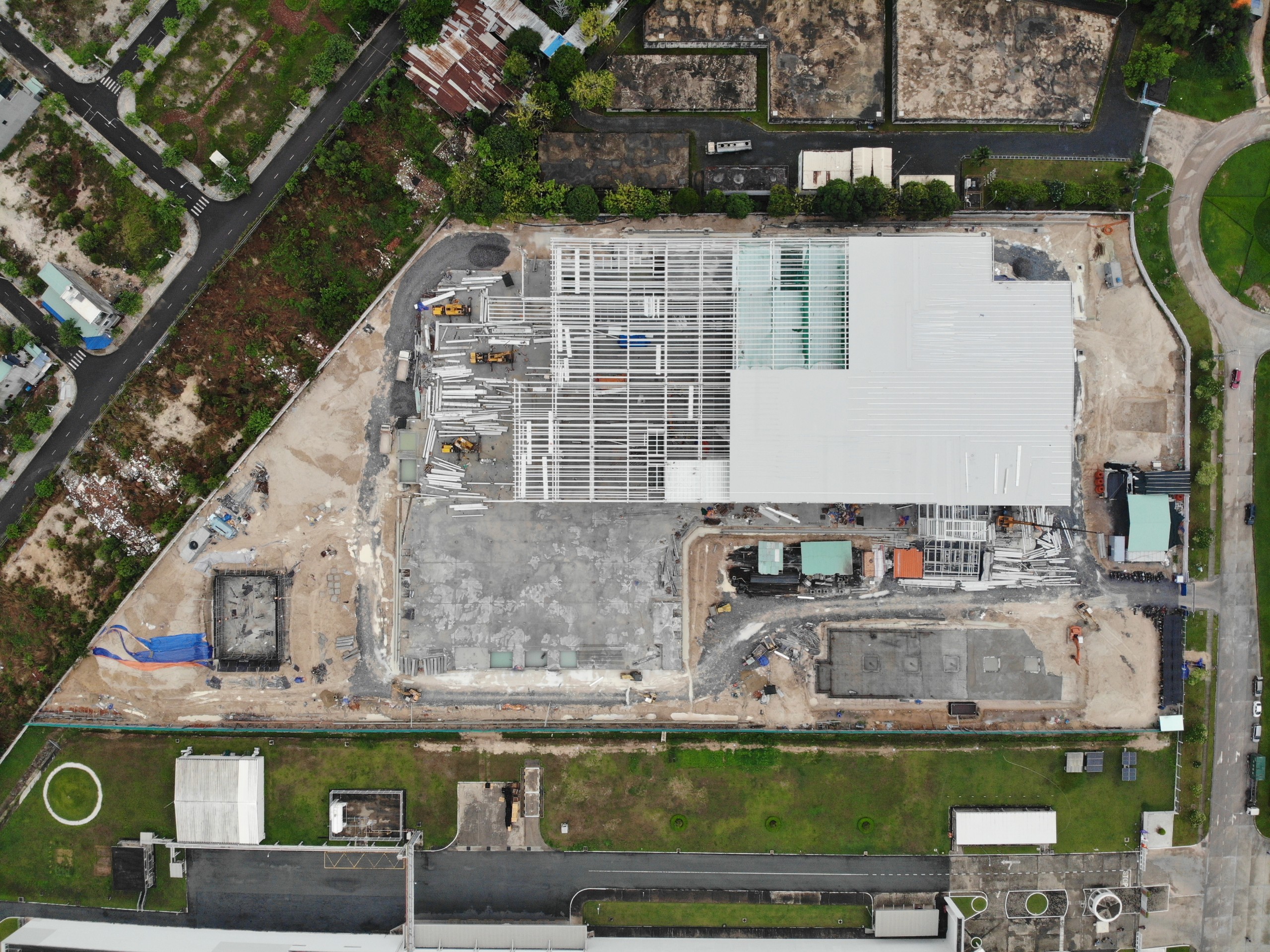

2021/04/27 (After begin construction 20 weeks)

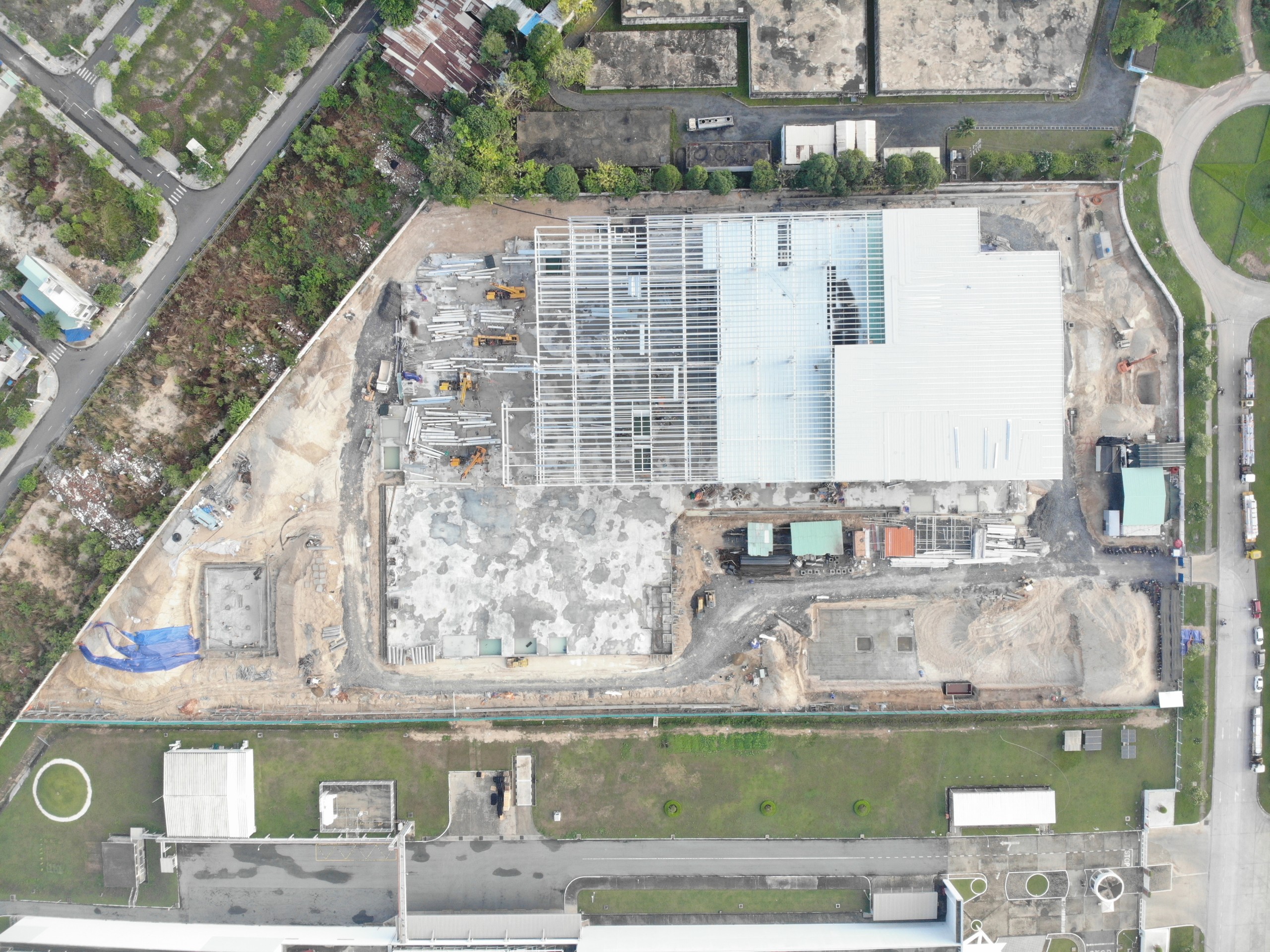

2021/04/20 (After begin construction 19 weeks)

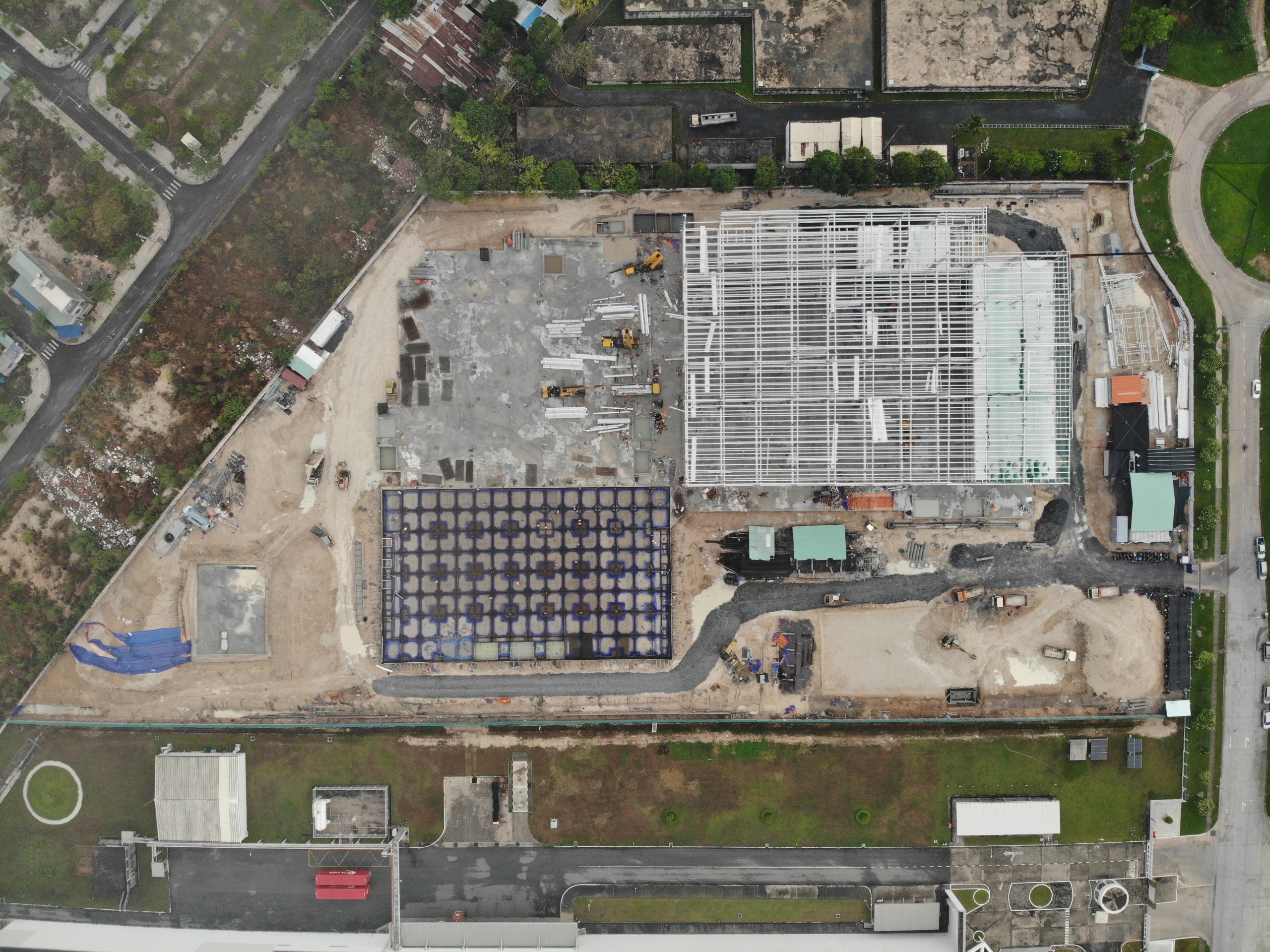

2021/04/13 (After begin construction 18 weeks)

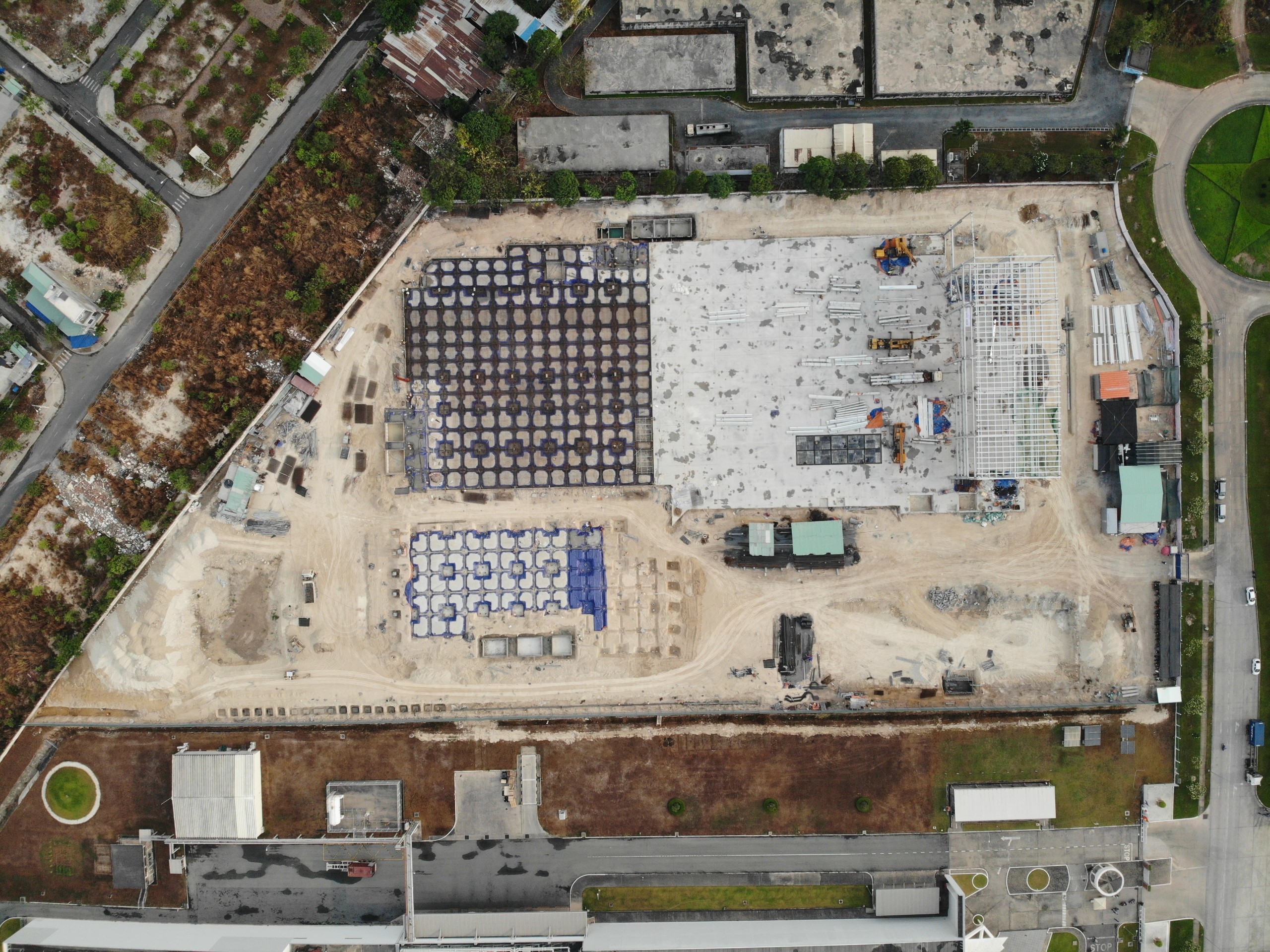

2021/04/06 (After begin construction 17 weeks)

2021/03/29 (After begin construction 16 weeks)

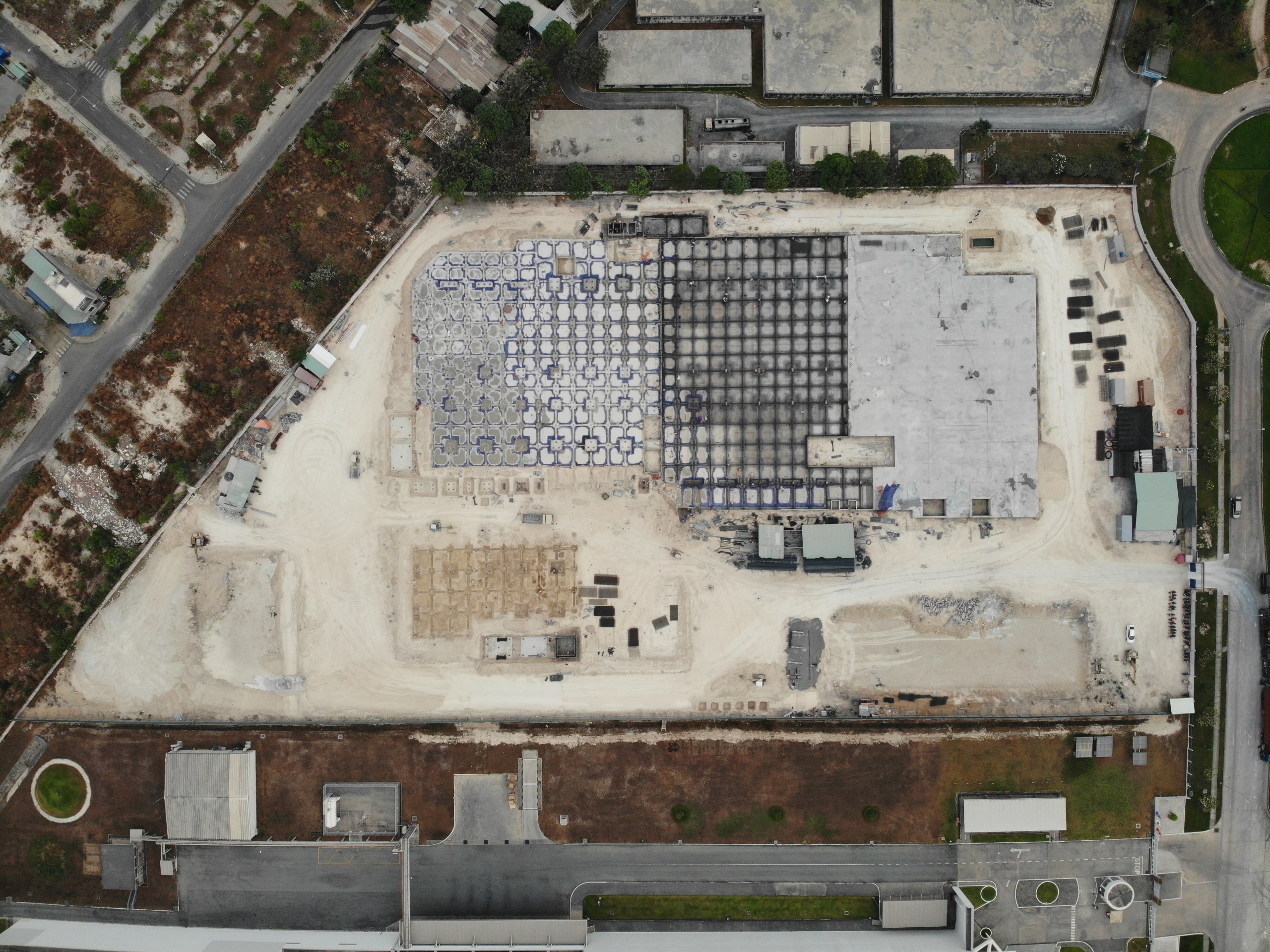

2021/03/20 (After begin construction 14 weeks)

2021/02/24 (After begin construction 11 weeks)

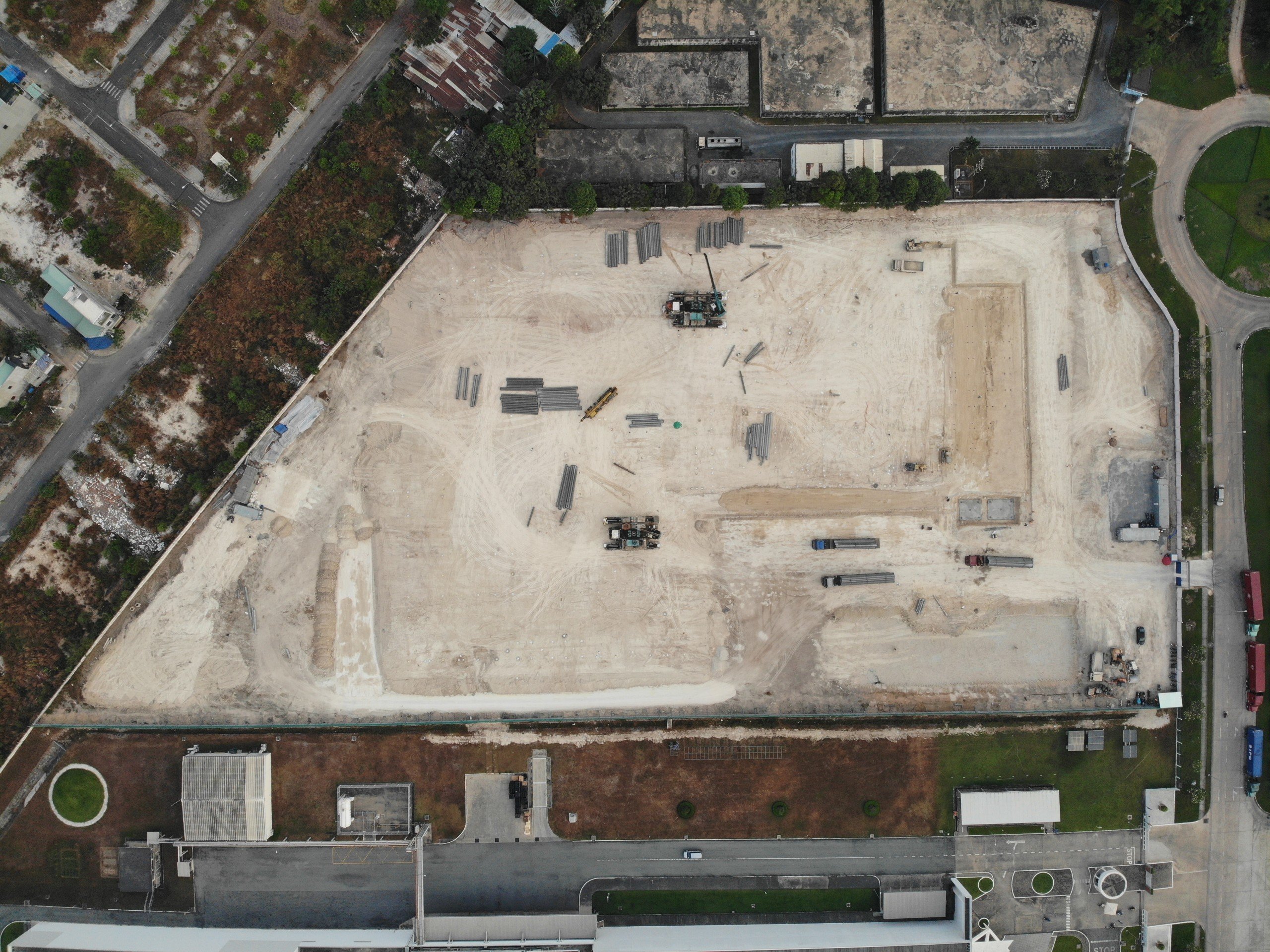

2021/01/28 (After begin construction 7 weeks)

2021/01/19 (After begin construction 6 weeks)

2020/12/29 (After begin construction 3 weeks)

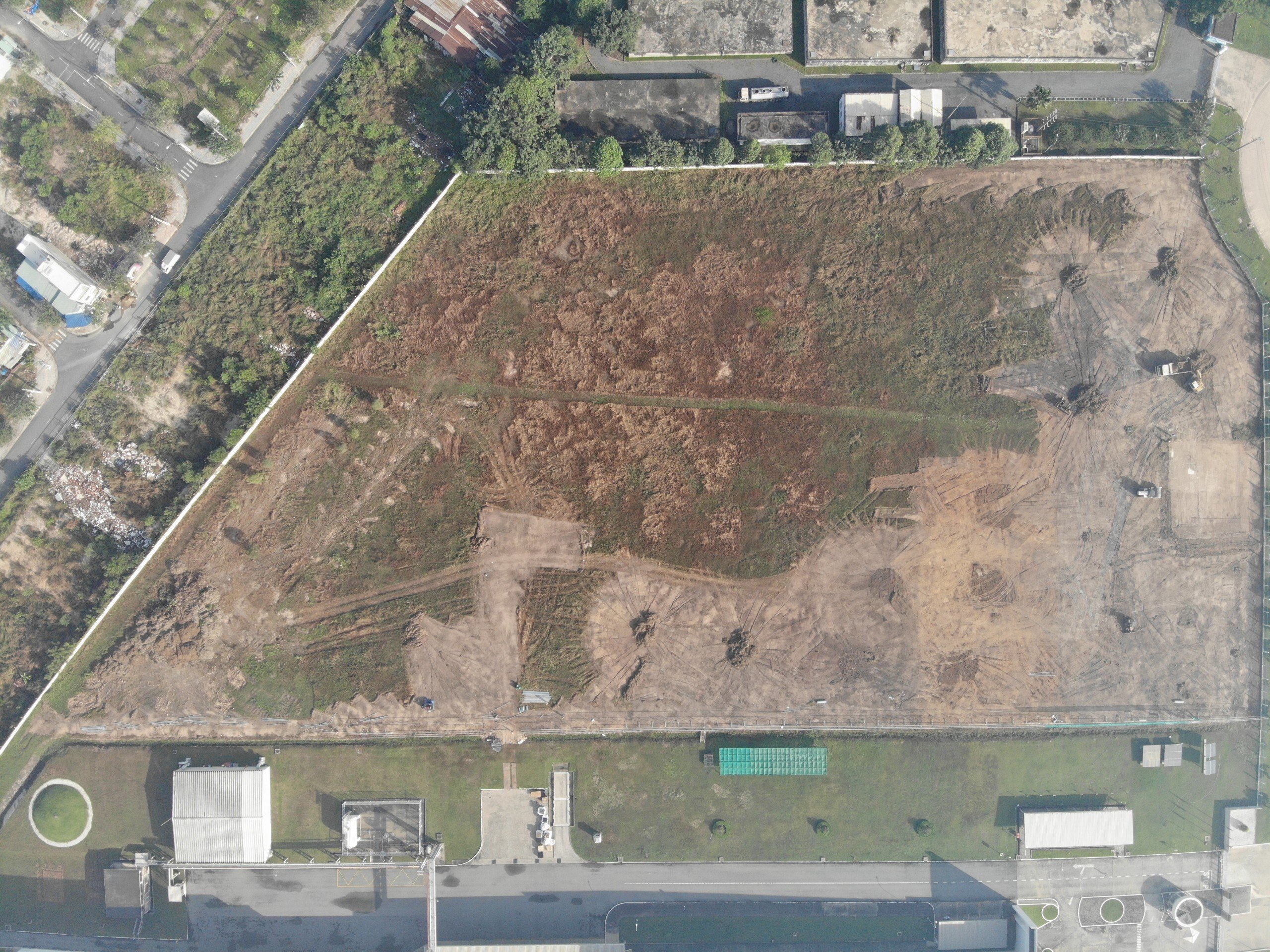

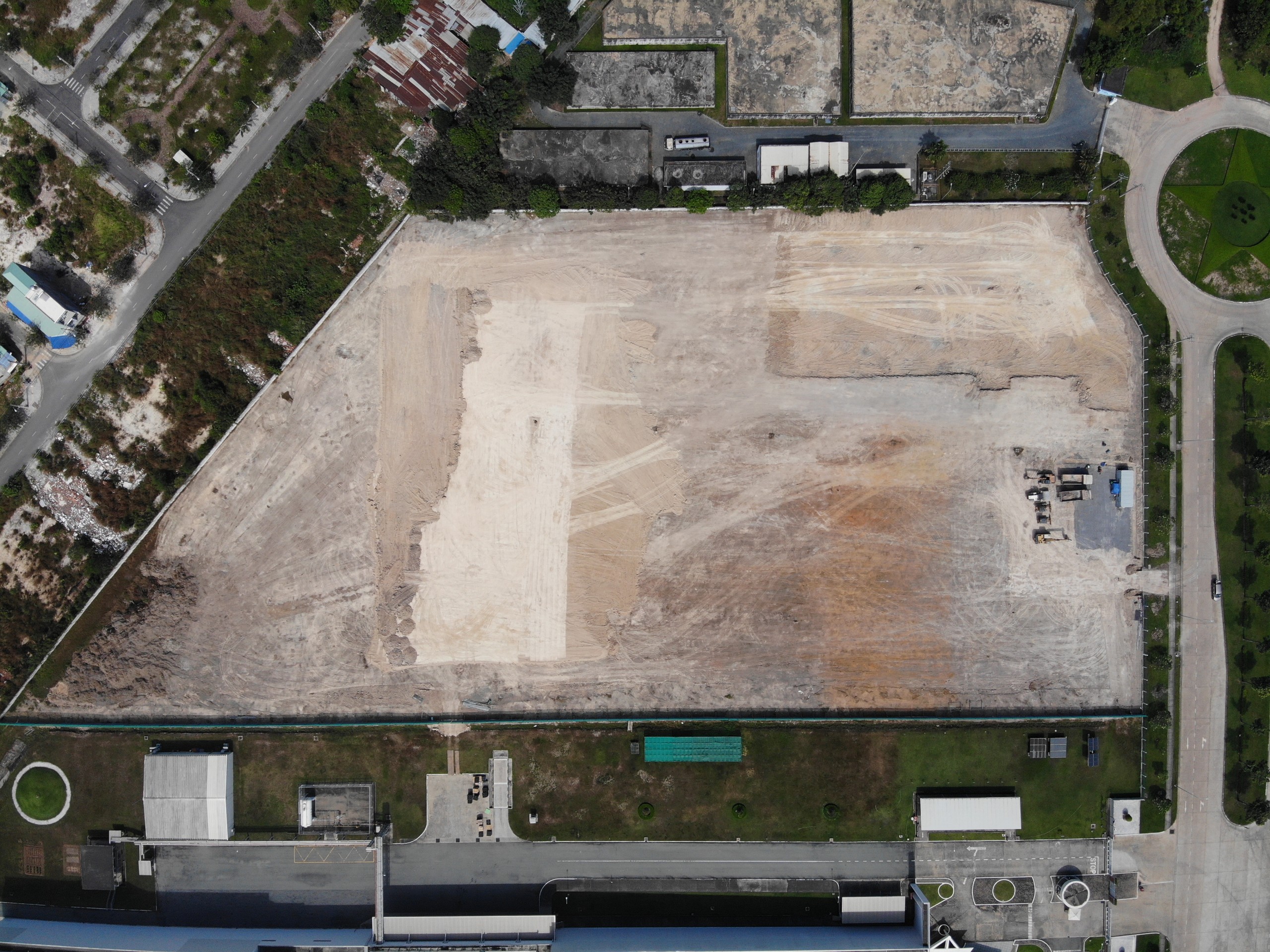

2020/12/16 (After begin construction 1 weeks)

Project Platel - Manufacturer's in Dong Nai
Period 2021
Location Long Binh, Thanh pho Bien Hoa, Dong Nai
GFA 32615.72 GFA (m2)
Status Completed
