Construction

Project Name Daemyung 5 Factory - Phase 4
2020/11/27 (After begin construction 20 weeks)


2020/11/18 (After begin construction 19 weeks)


2020/11/11 (After begin construction 18 weeks)

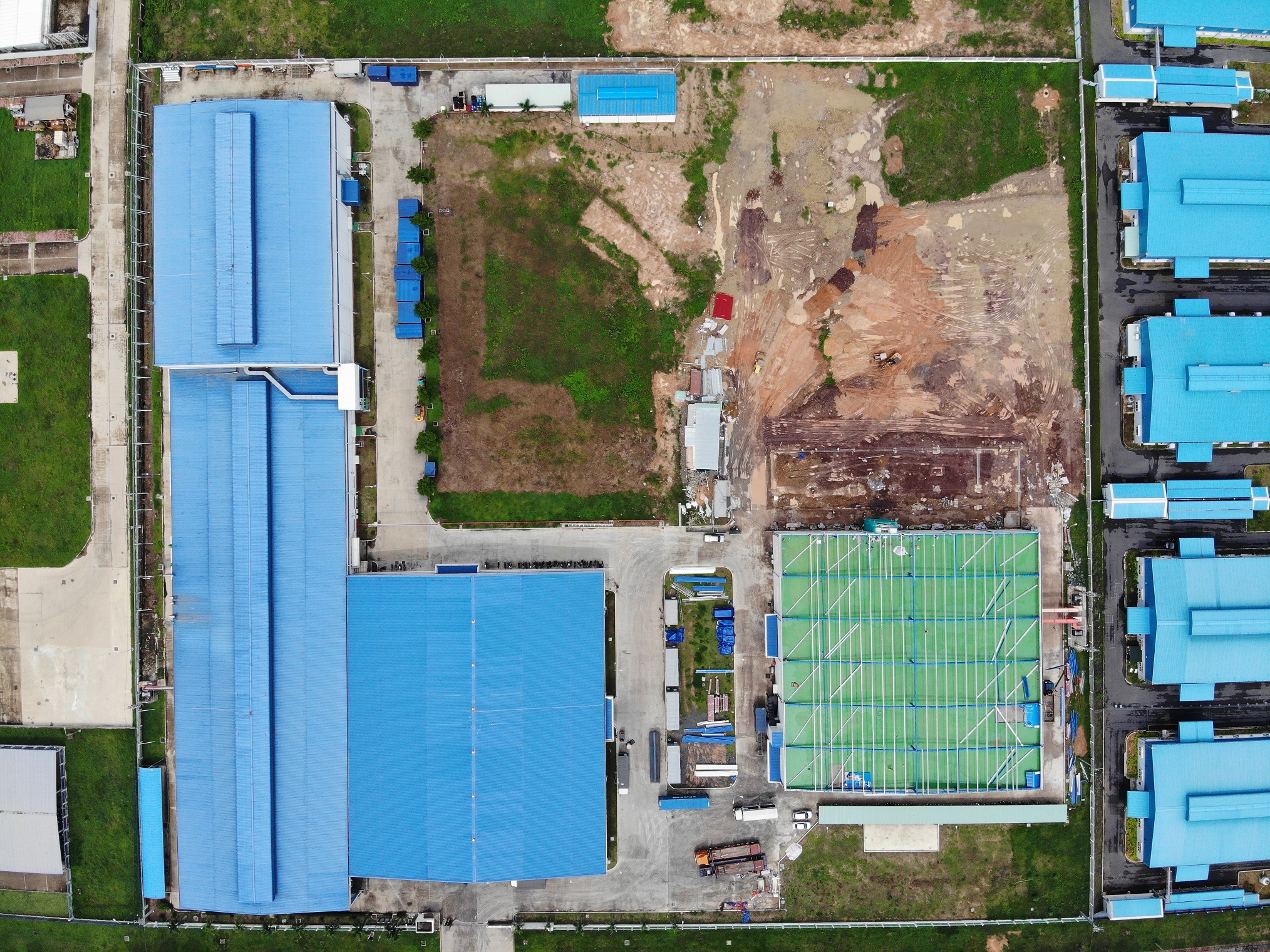

2020/10/21 (After begin construction 17 weeks)


2020/10/12 (After begin construction 16 weeks)


2020/10/02 (After begin construction 15 weeks)


2020/09/25 (After begin construction 14 weeks)


2020/09/18 (After begin construction 13 weeks)


2020/09/09 (After begin construction 12 weeks)


2020/09/03 (After begin construction 11 weeks)

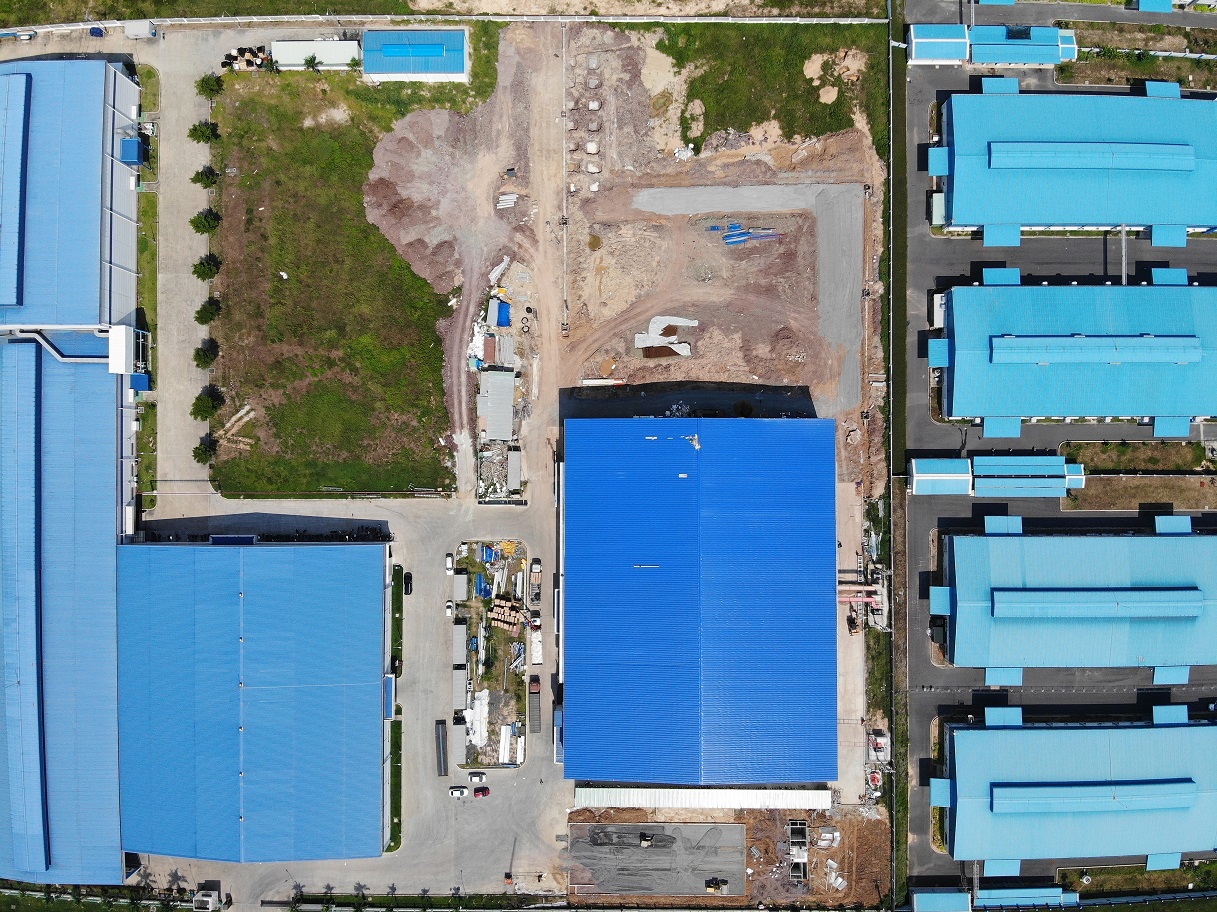

2020/08/25 (After begin construction 10 weeks)

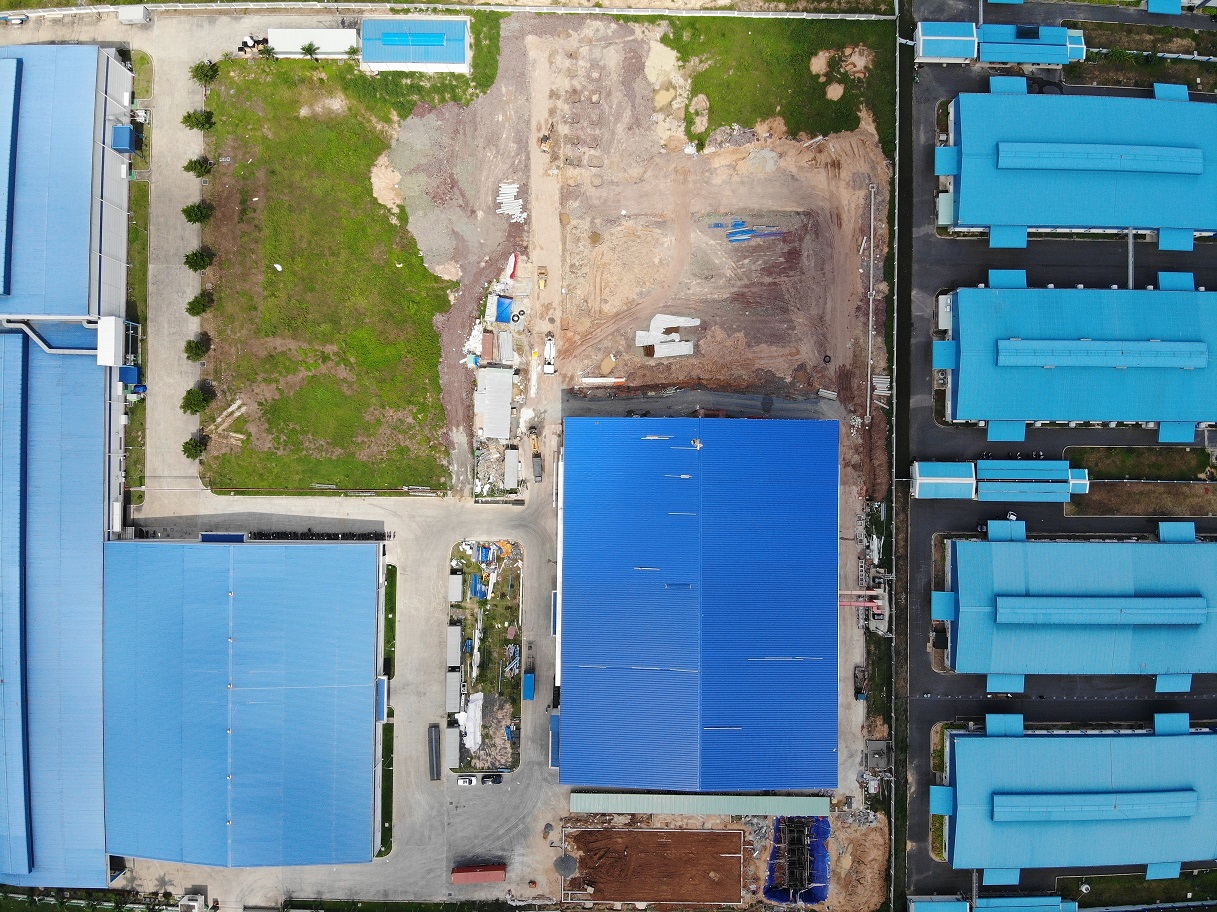

2020/08/18 (After begin construction 9 weeks)

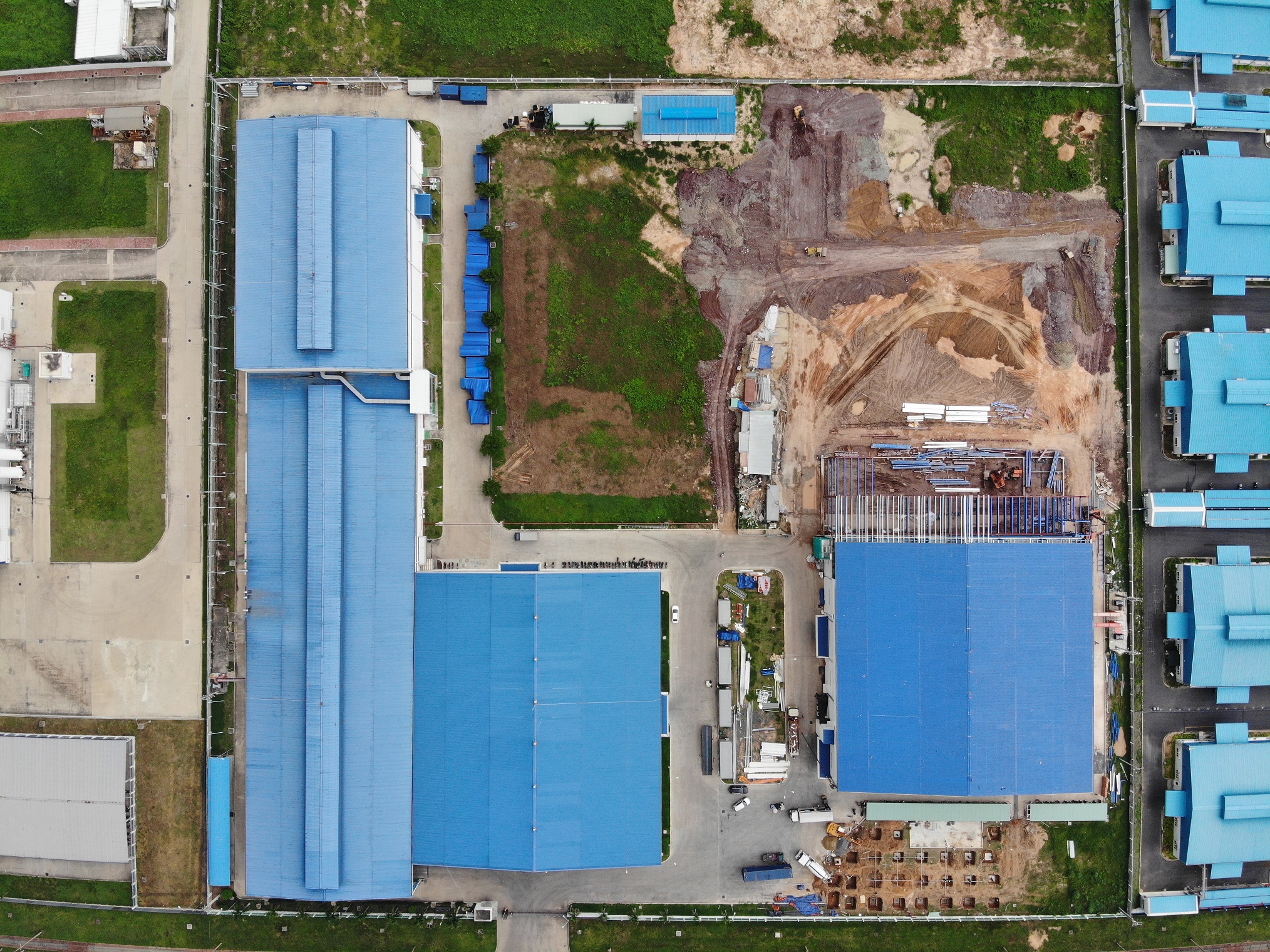

2020/07/21 (After begin construction 6 weeks)

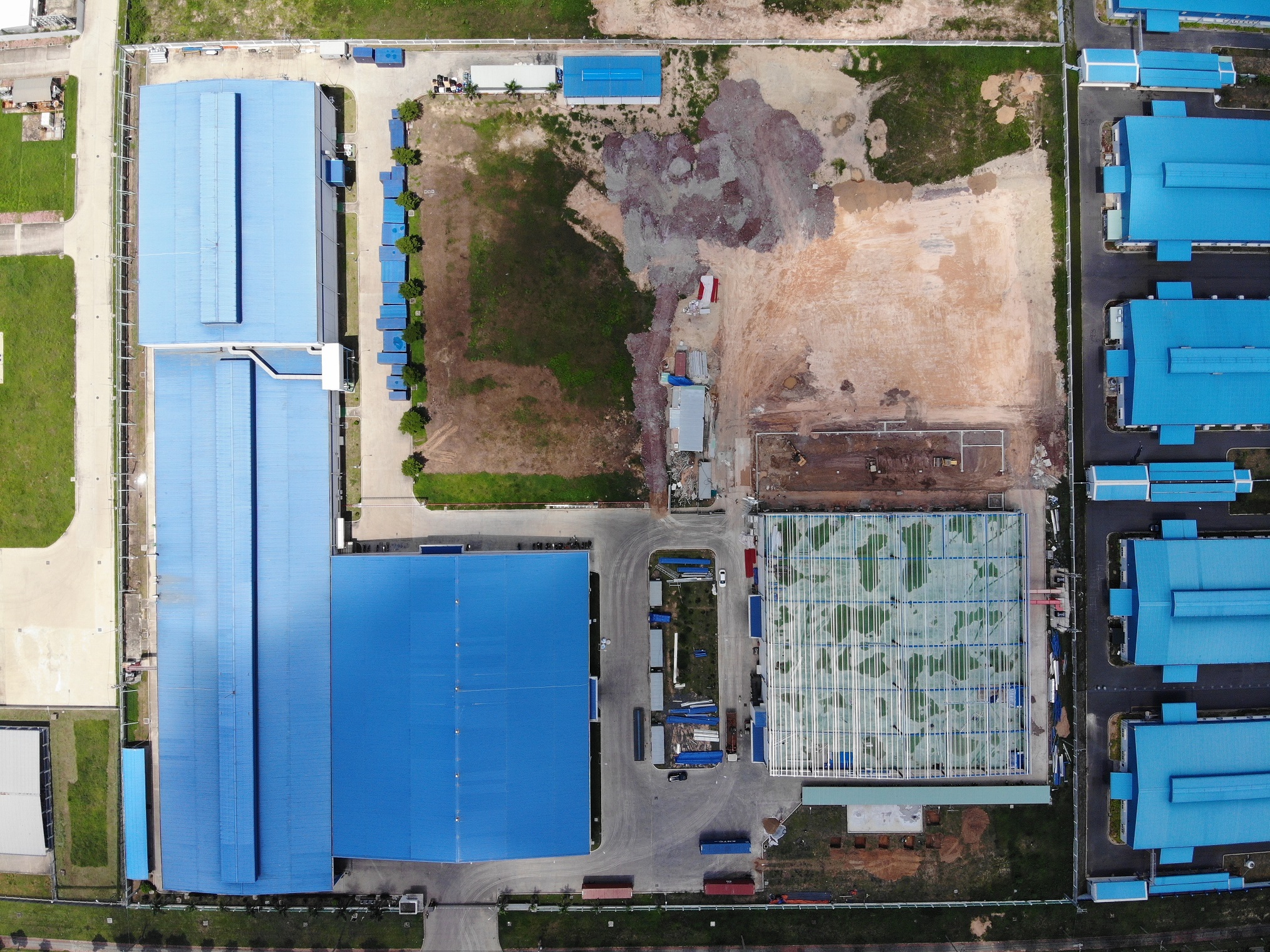

2020/07/14 (After begin construction 5 weeks)

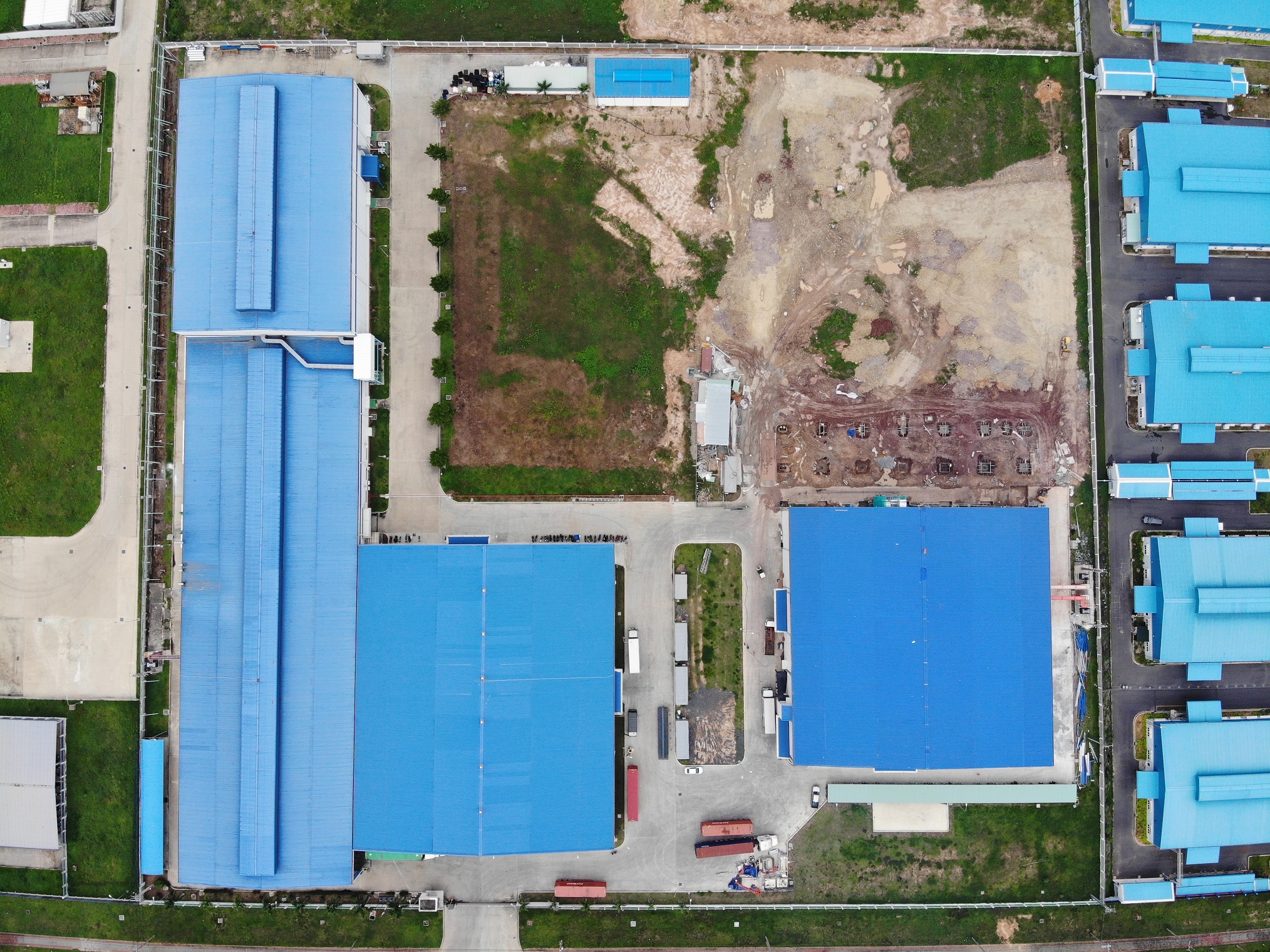

2020/07/07 (After begin construction 4 weeks)


2020/06/30 (After begin construction 3 weeks)

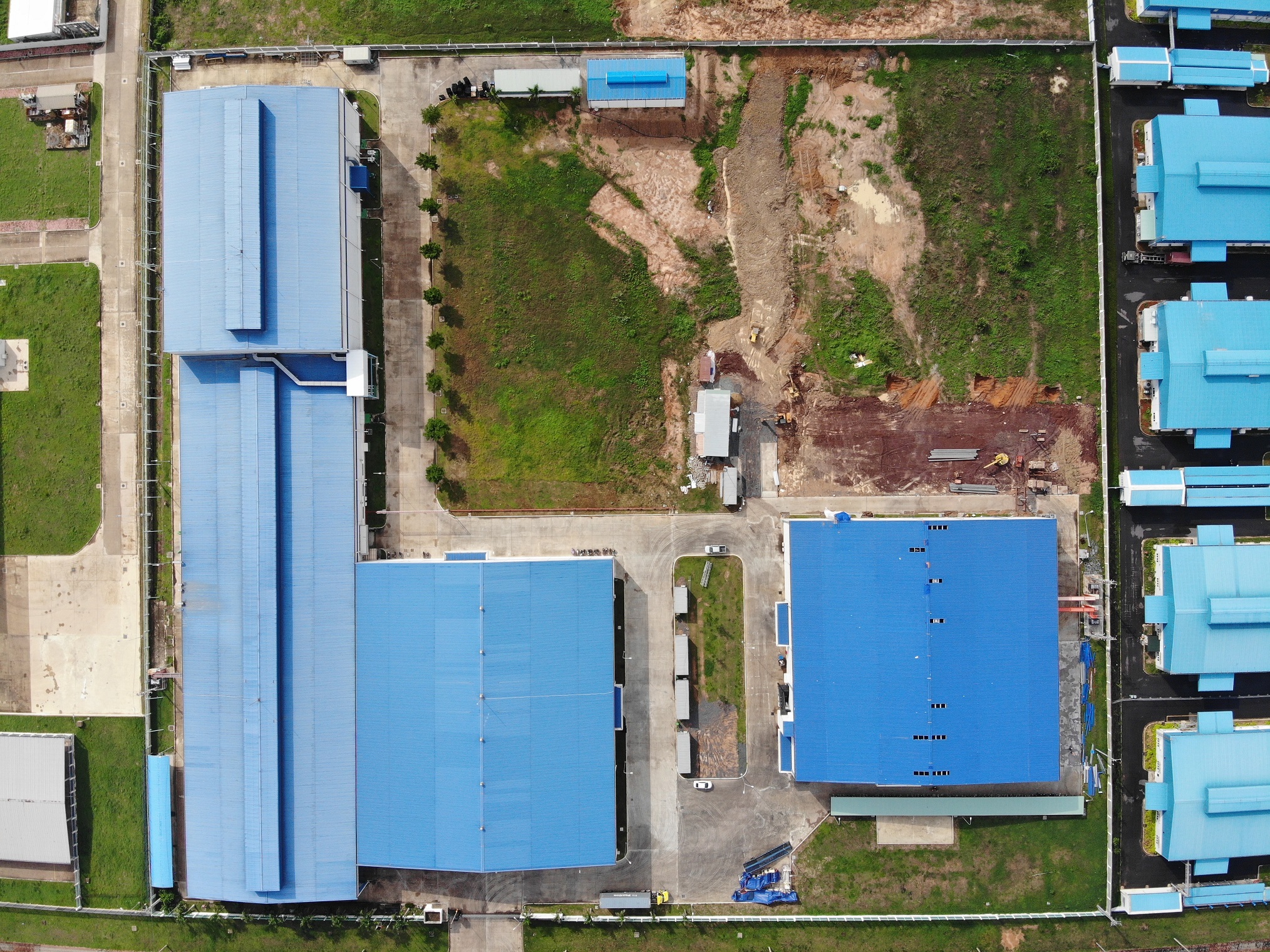

2020/06/23 (After begin construction 2 weeks)

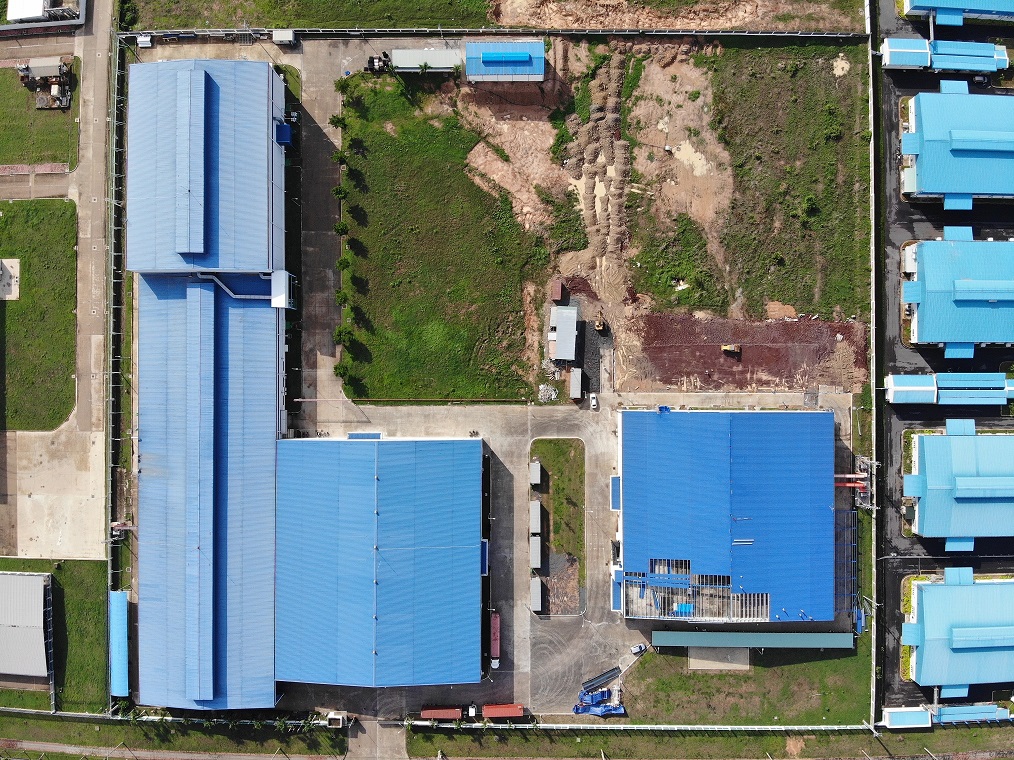

2020/06/16 (After begin construction 1 weeks)

Project Daemyung Chemical Vina Co., Ltd.
Period 2020
Location Long Thanh IP, Dong Nai Province
GFA 4652 GFA (m2)
Status Completed
